Project Details - Symbiosis World School

Residential

SYMBIOSIS WORLD SCHOOL

Basement, building, terrace, podium, and ramp waterproofing work.

Timeline 2 Years
Total Area 2,00,000 Sqft
Budget 4 Crore
Buildings 5 Buildings

Execution Details

A comprehensive approach to the waterproofing structure utilizing detailed step-by-step methodology to ensure absolute stability and robustness across various functional areas of the facility.

  • Basement: Expansion joint, retaining wall waterproofing work
  • UGWT: Top and outer shabad waterproofing work
  • Building Areas: Toilets, balconies, kitchens, dry balconies, lift pit, domes, entrance gate waterproofing work
  • Terrace: Terrace Waterproofing Work
  • Podium: Podium Waterproofing Work
  • Ramp: Ramp Waterproofing Work

Project Specifications

Building Type Residential
Client Symbiosis
Location Pune, Maharashtra
Sustainability Premium Build
Start Date 26-08-2024
Expected Completion 01-01-2027
Project Progress 70%

Toilets, Bathrooms & Balcony Waterproofing

Step 1: Surface Preparation

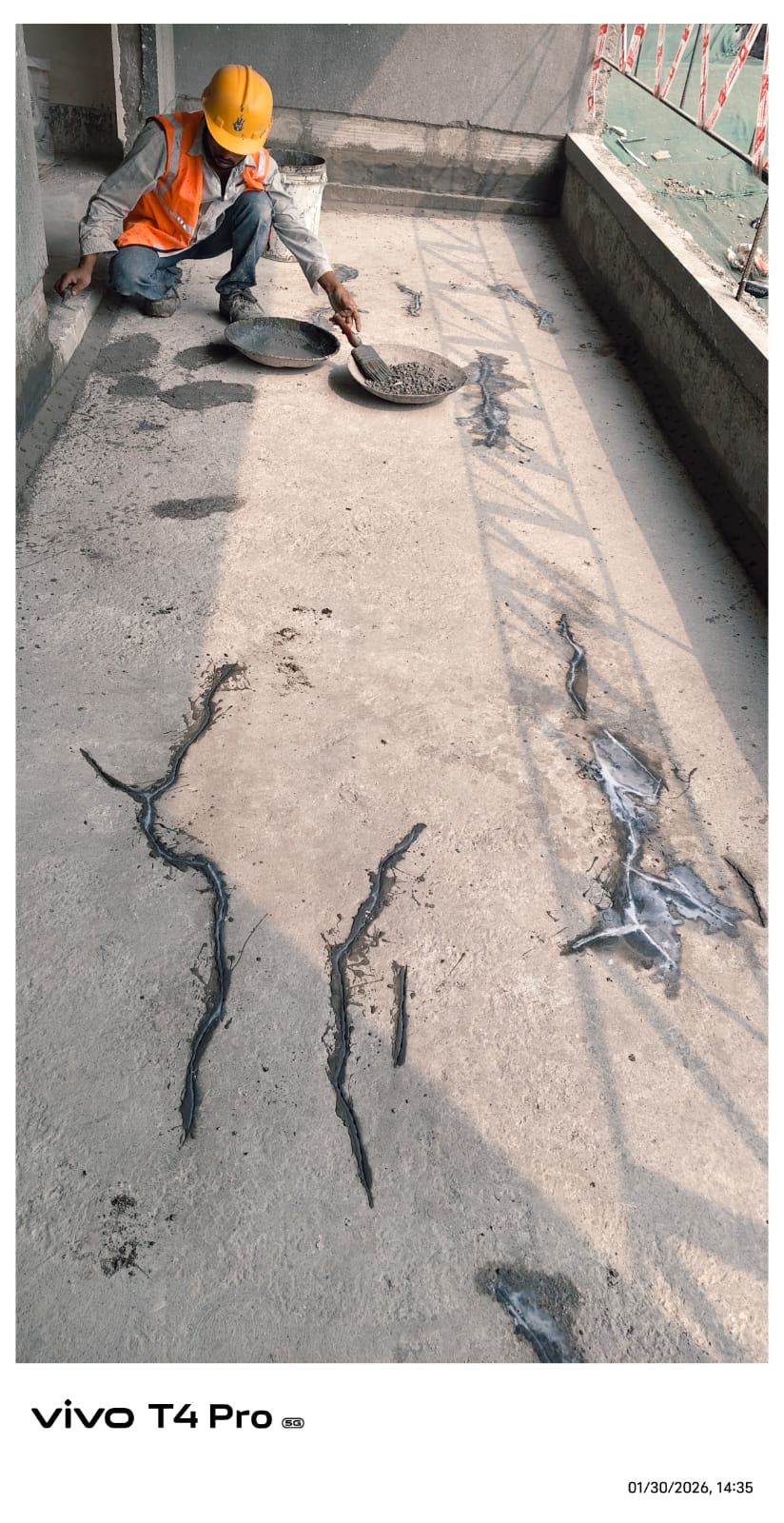

Surface Preparation 1

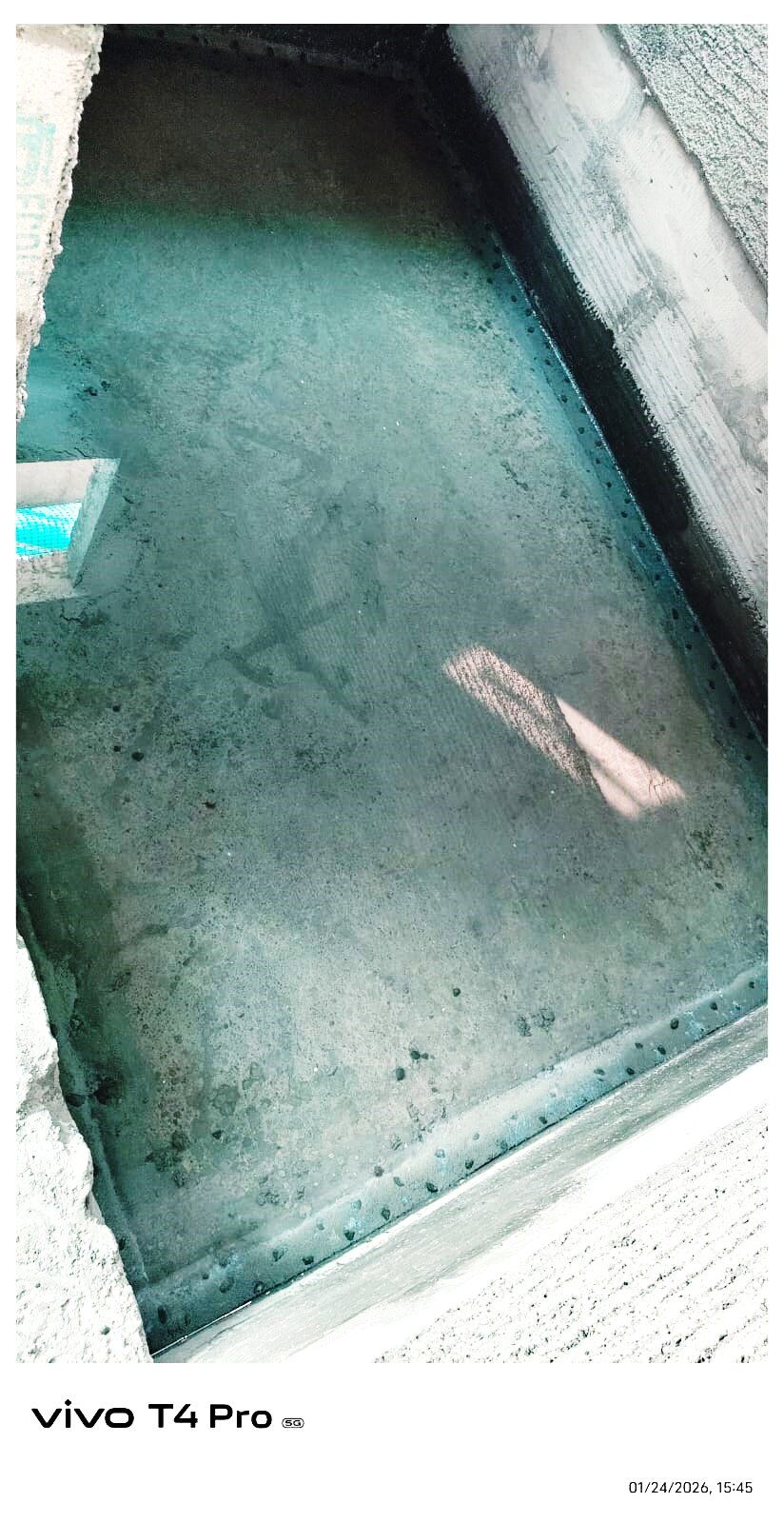

Surface Preparation 2

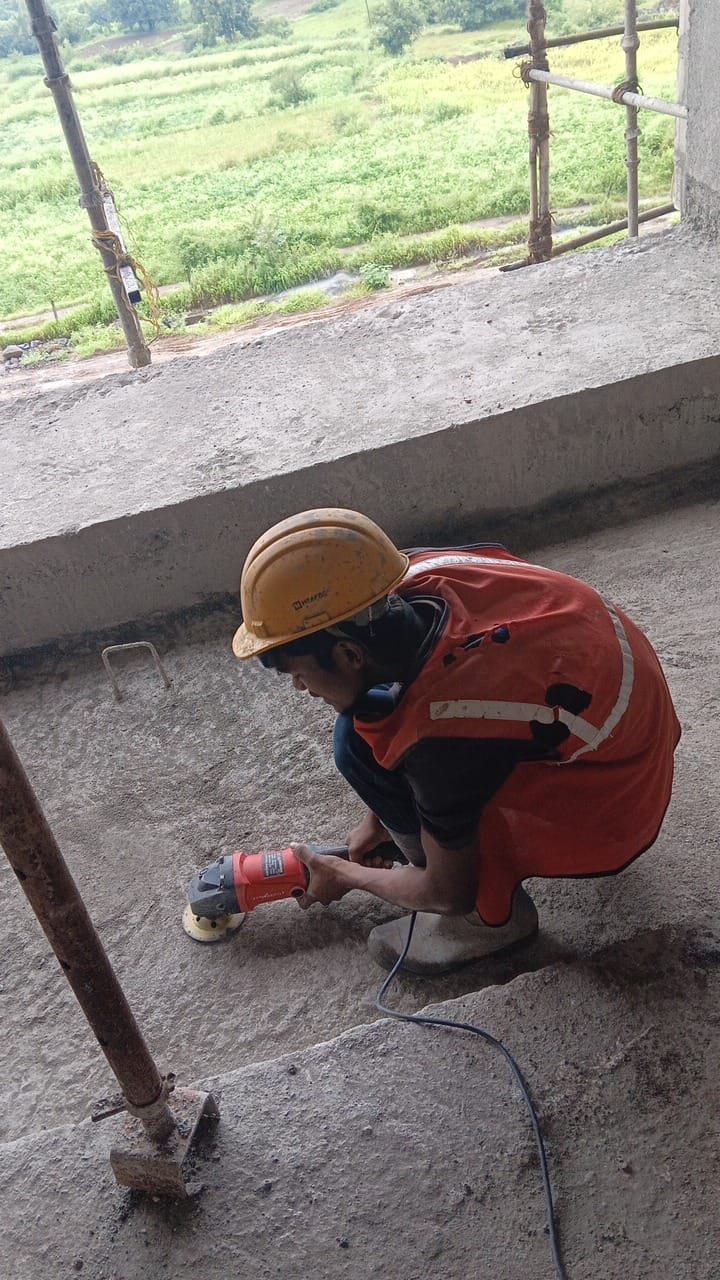

Surface Preparation 3

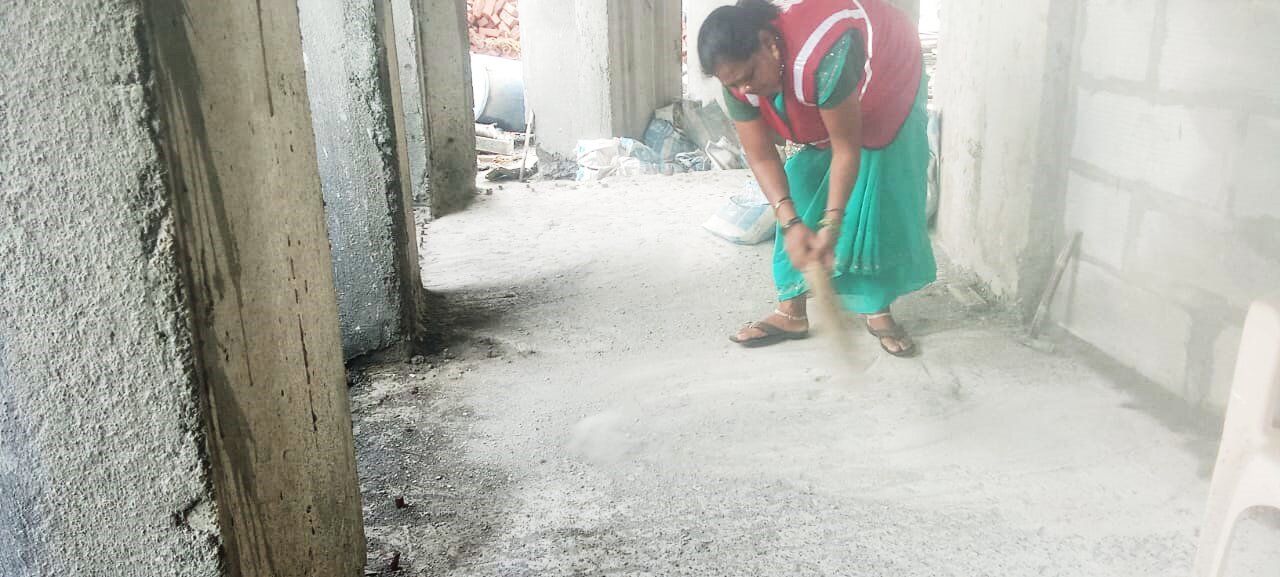

Surface Preparation 4

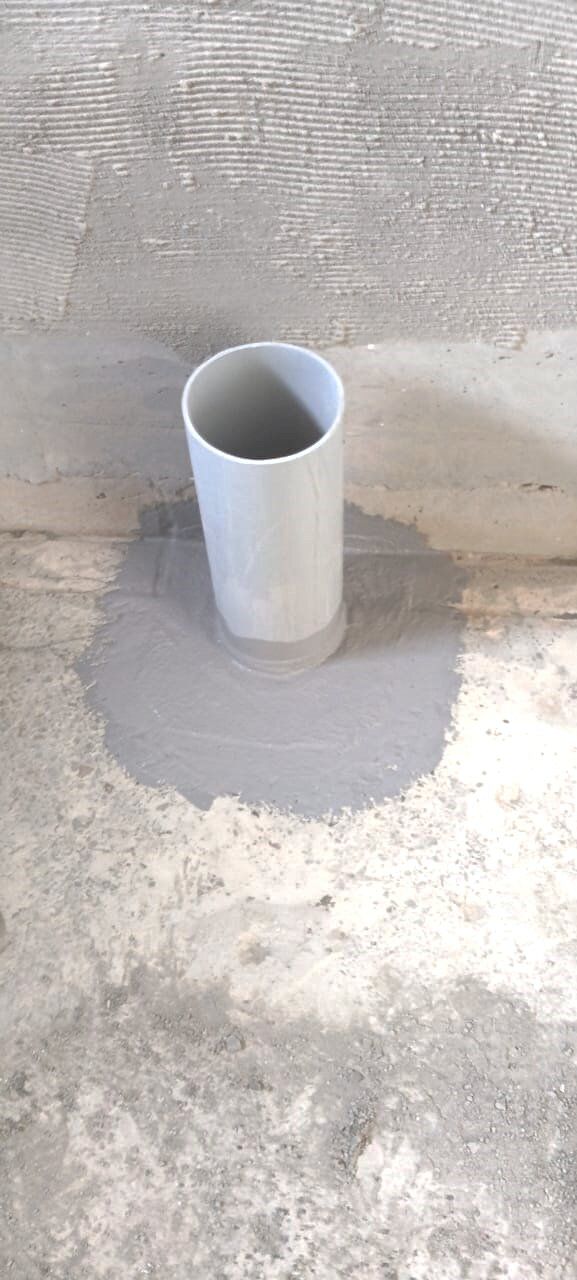

Surface Preparation 5
Surface Preparation 6

Step 2: Pre Pond Test

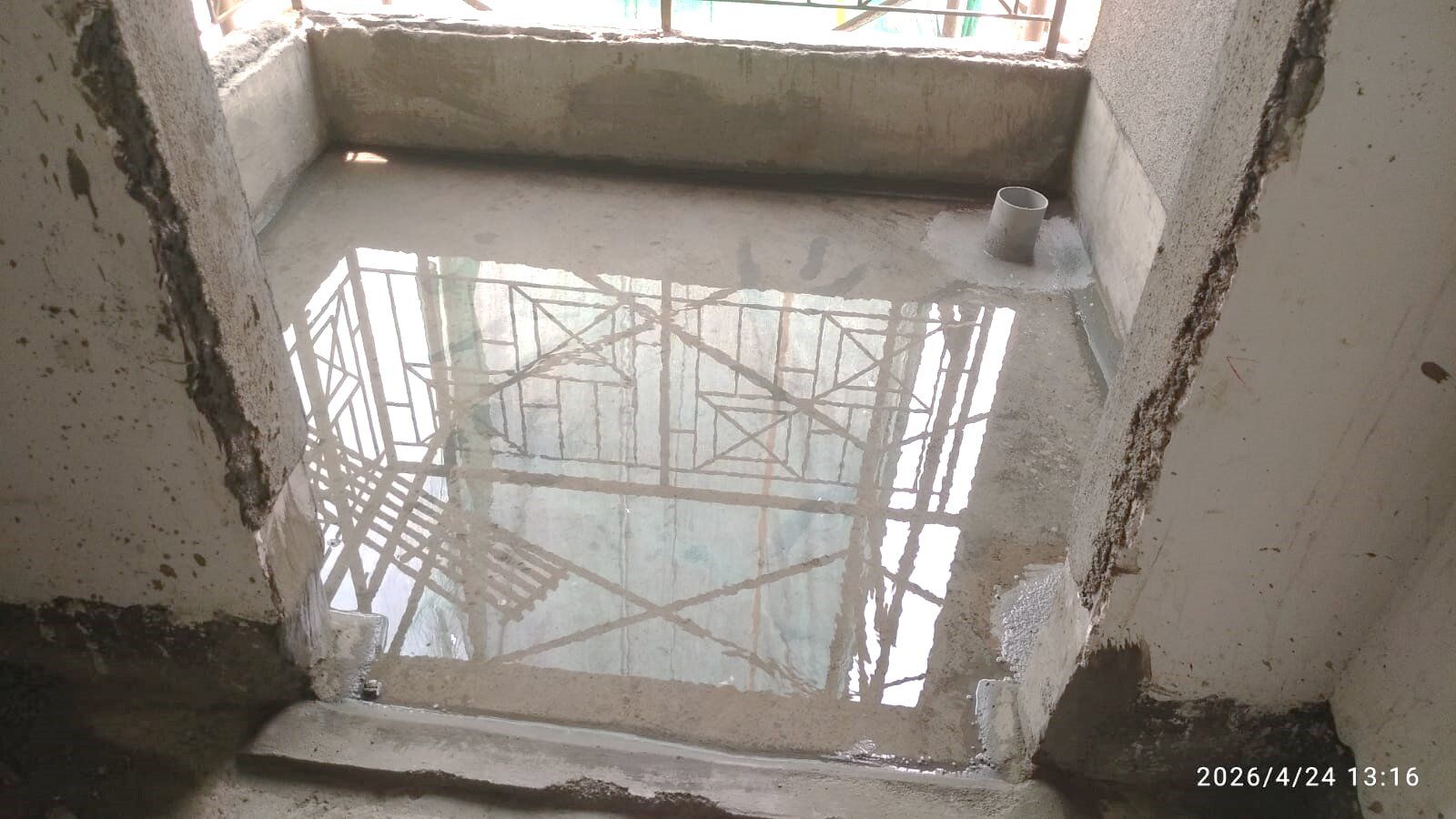

Pre Pond Test 1

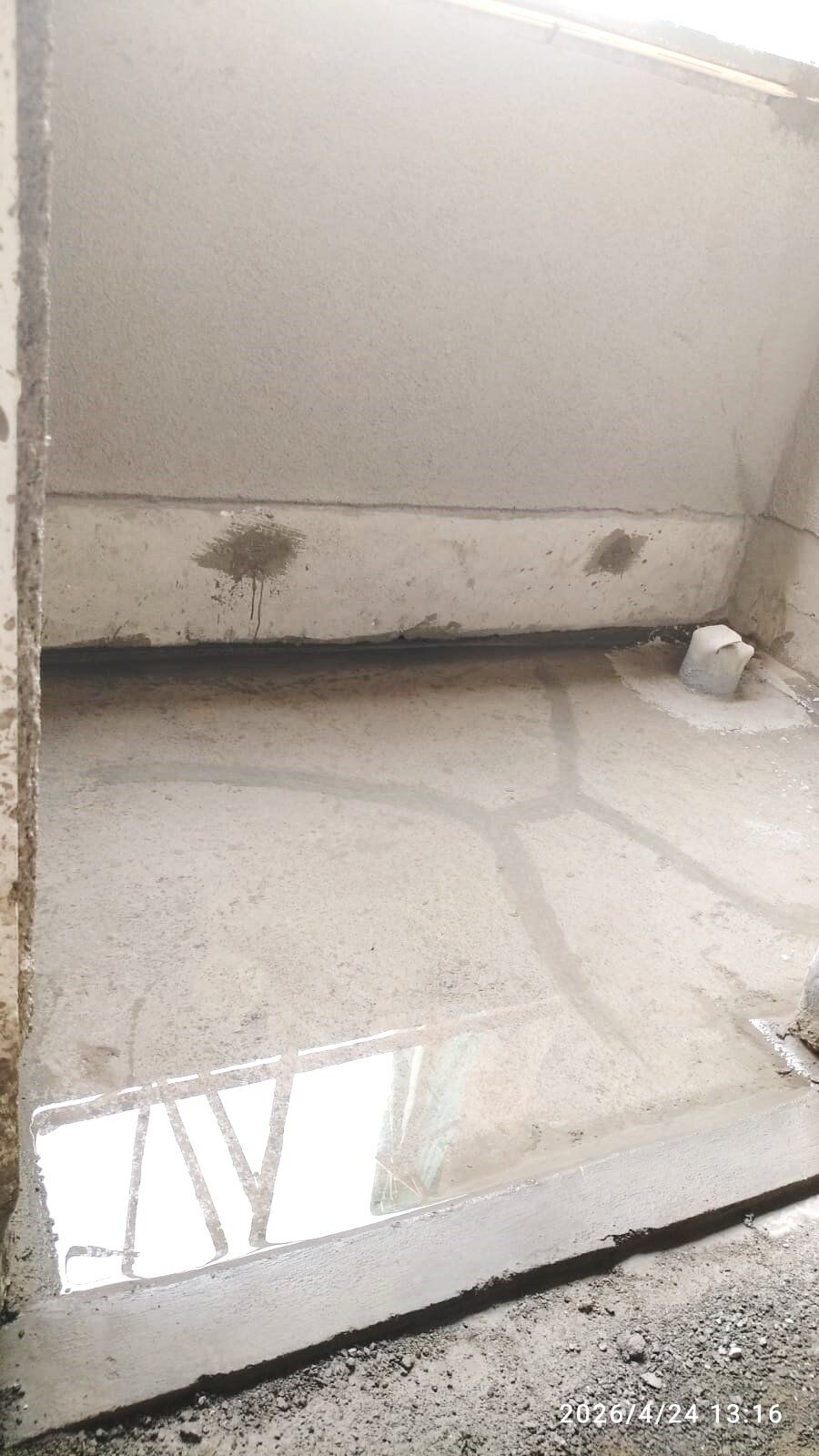

Pre Pond Test 2

Step 3: Chemical Coat

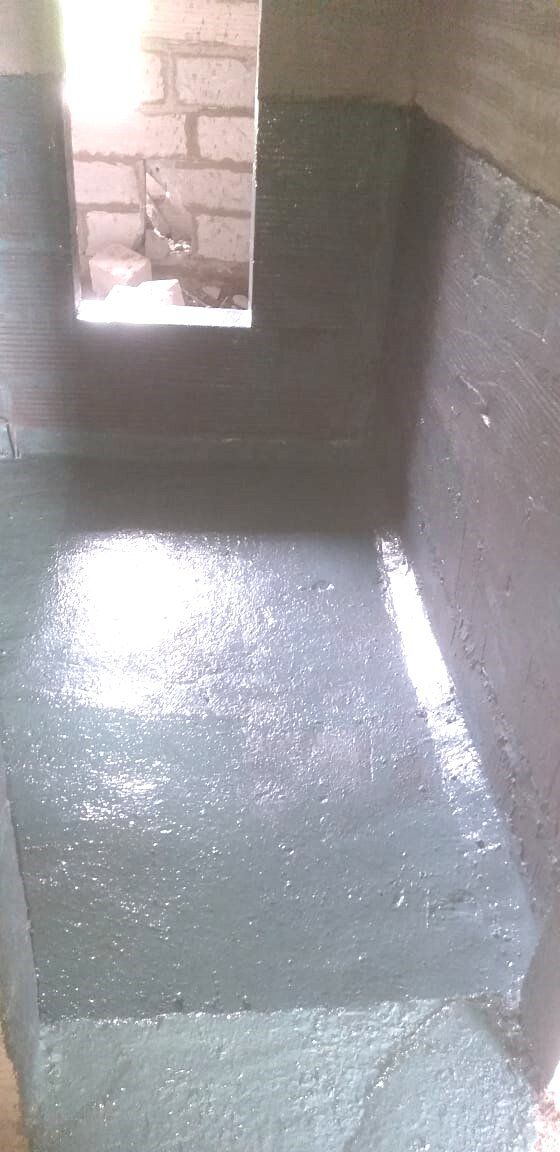

Chemical Coat 1

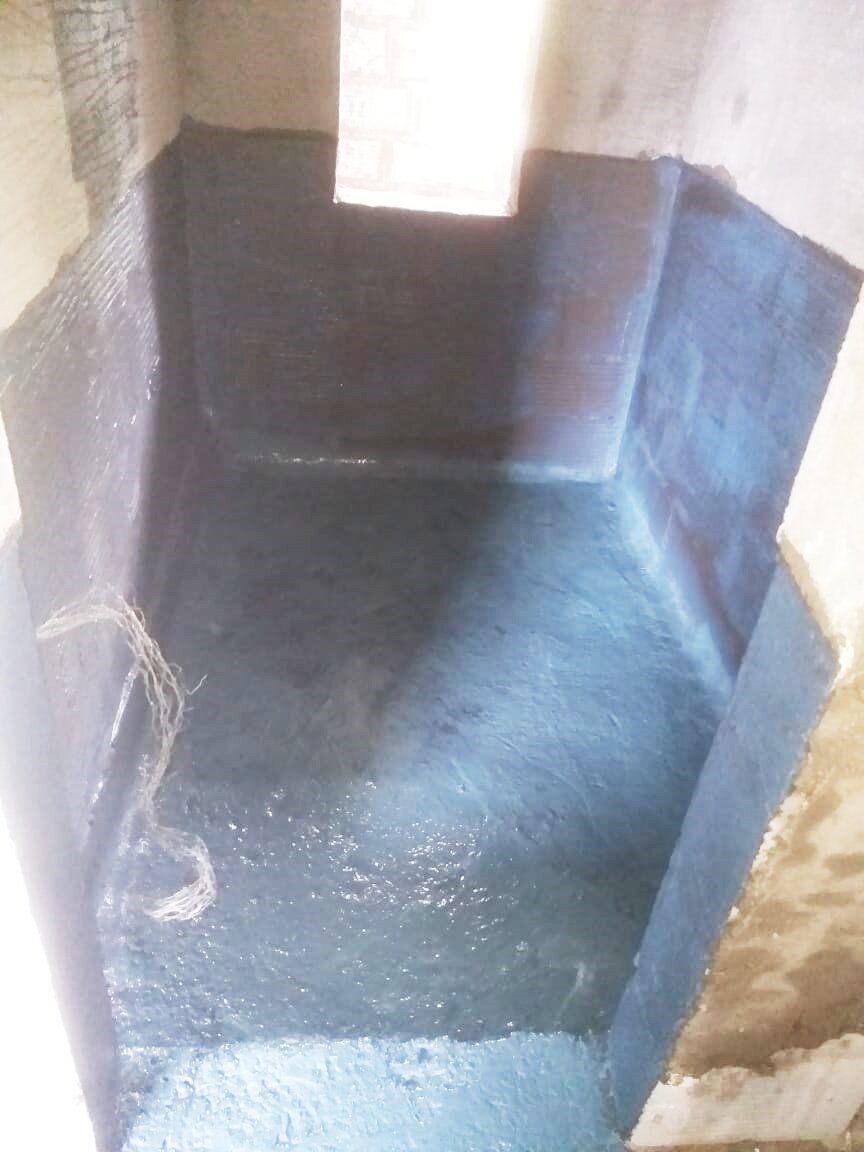

Chemical Coat 2

Step 4: Base Coat

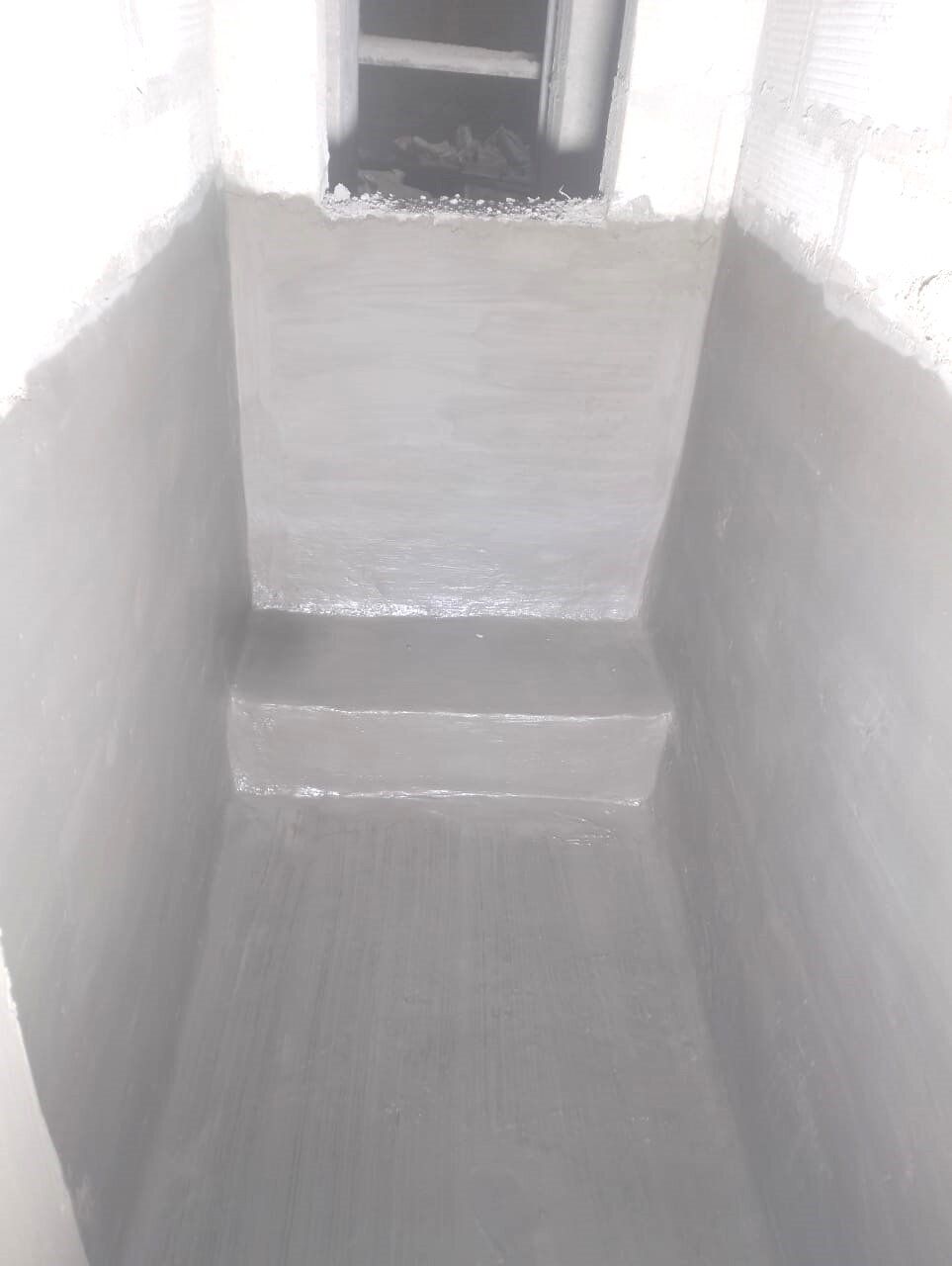

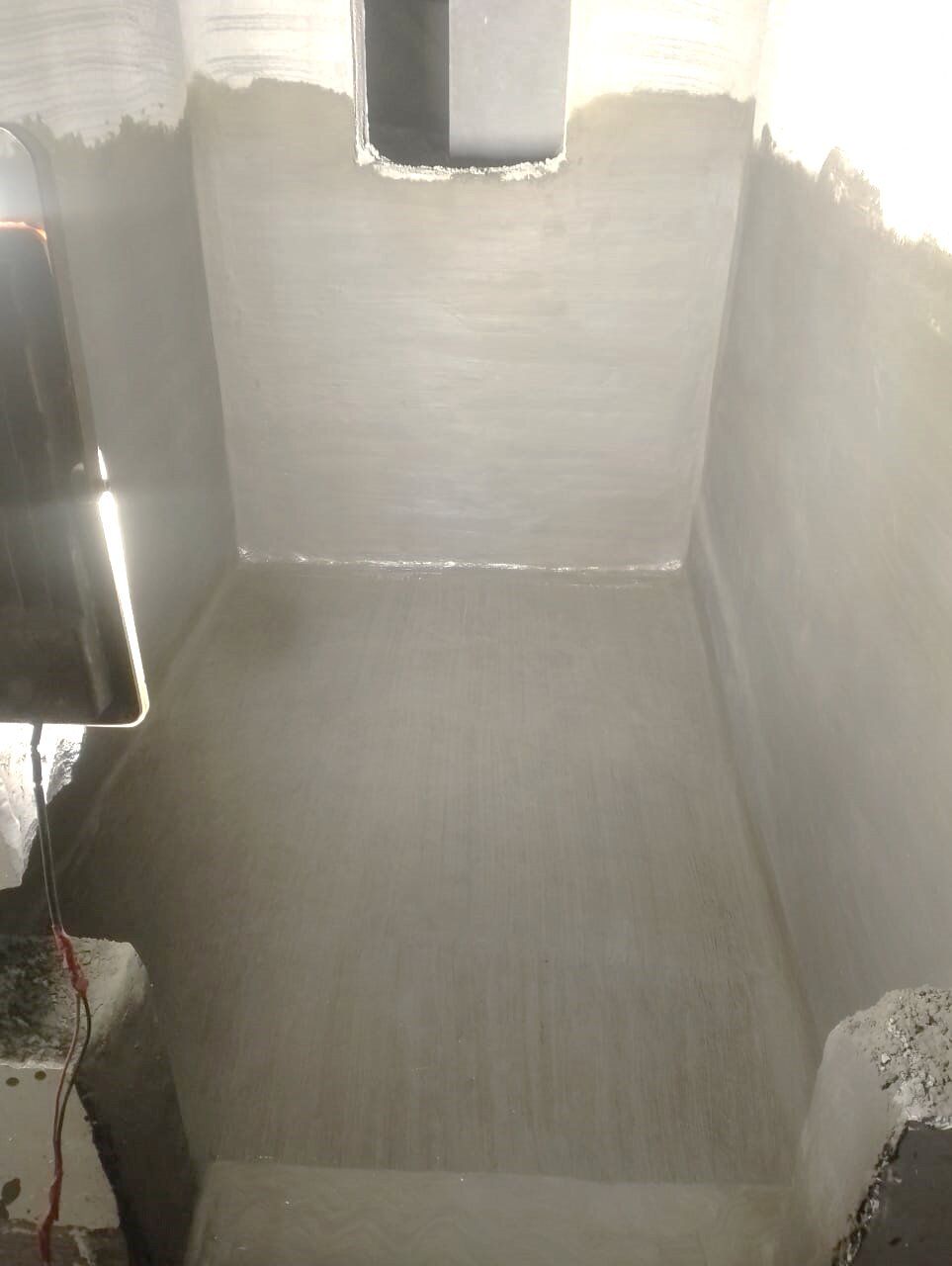

Base Coat 1
Base Coat 2

Step 5: Brick Bat & Finishing

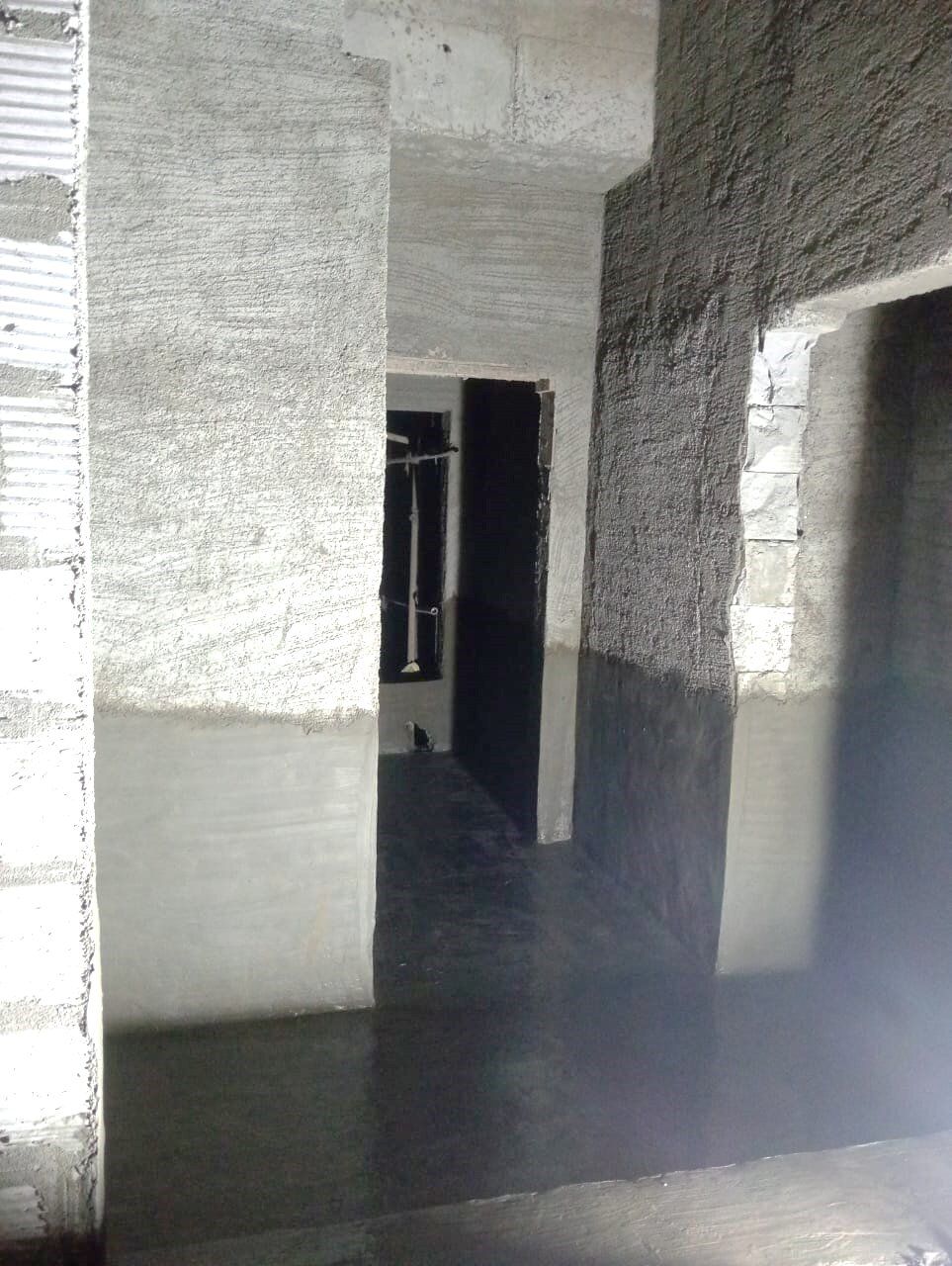

Brick Bat 1

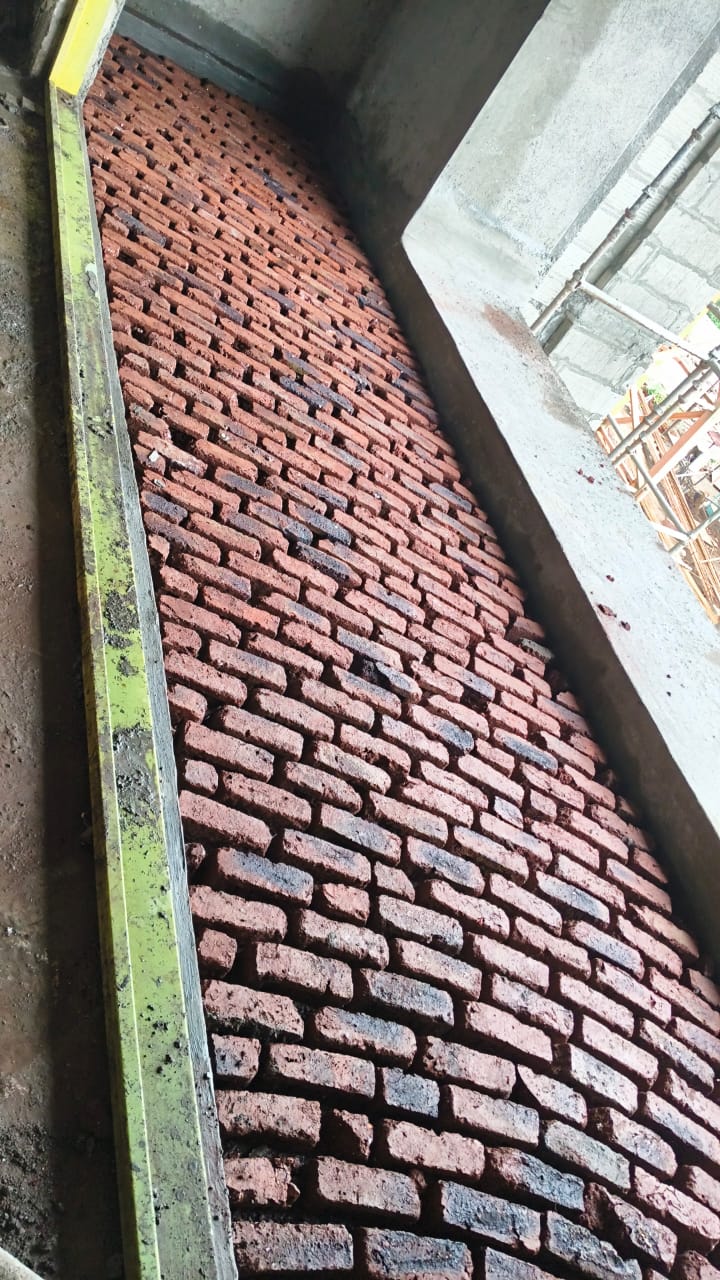

Brick Bat 2

Step 6: Post Pond Test

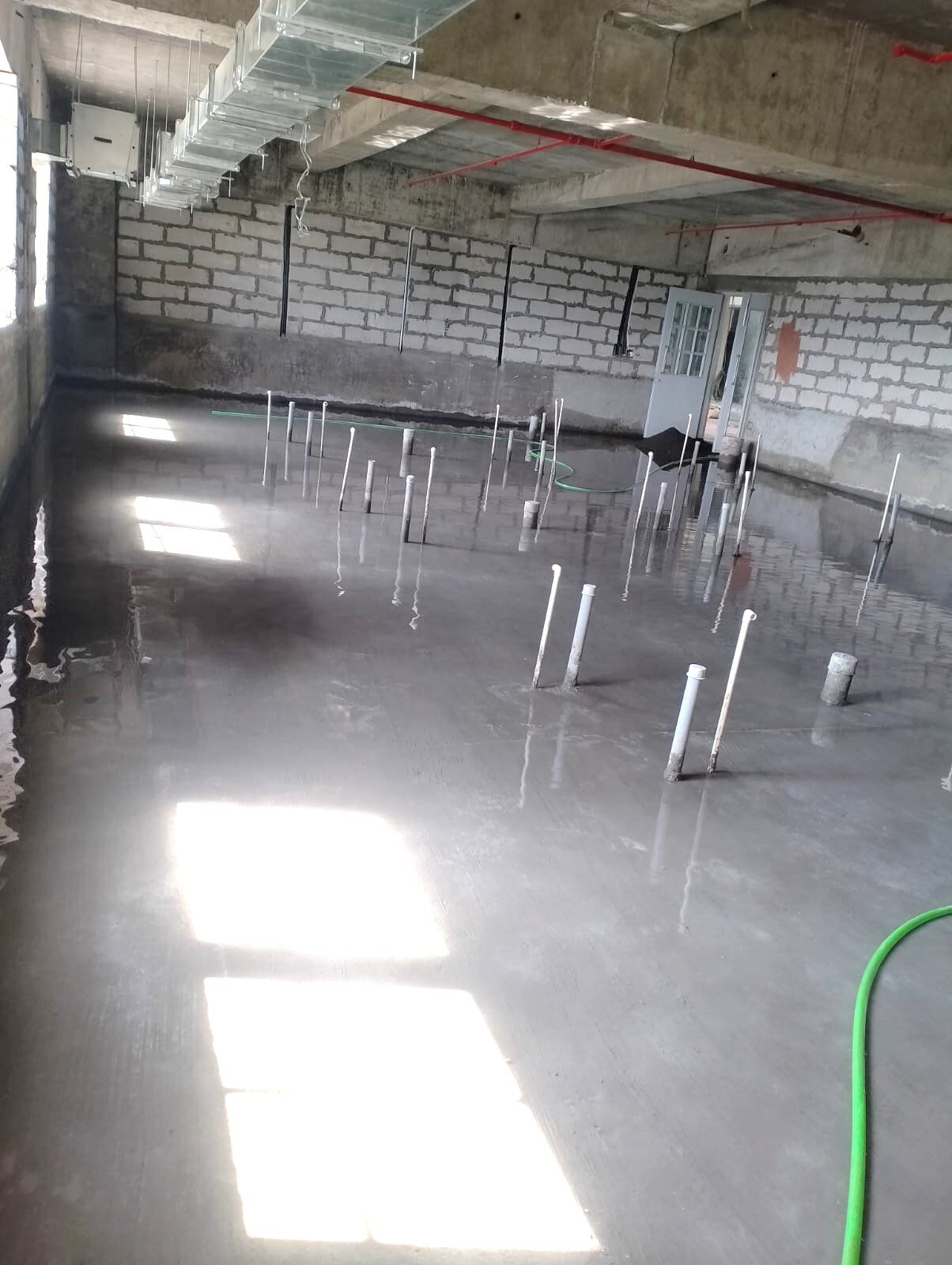

Post Pond Test 1
Post Pond Test 2

Terrace Waterproofing

Step 1: Chemical Coating & Brick Bat Finishing

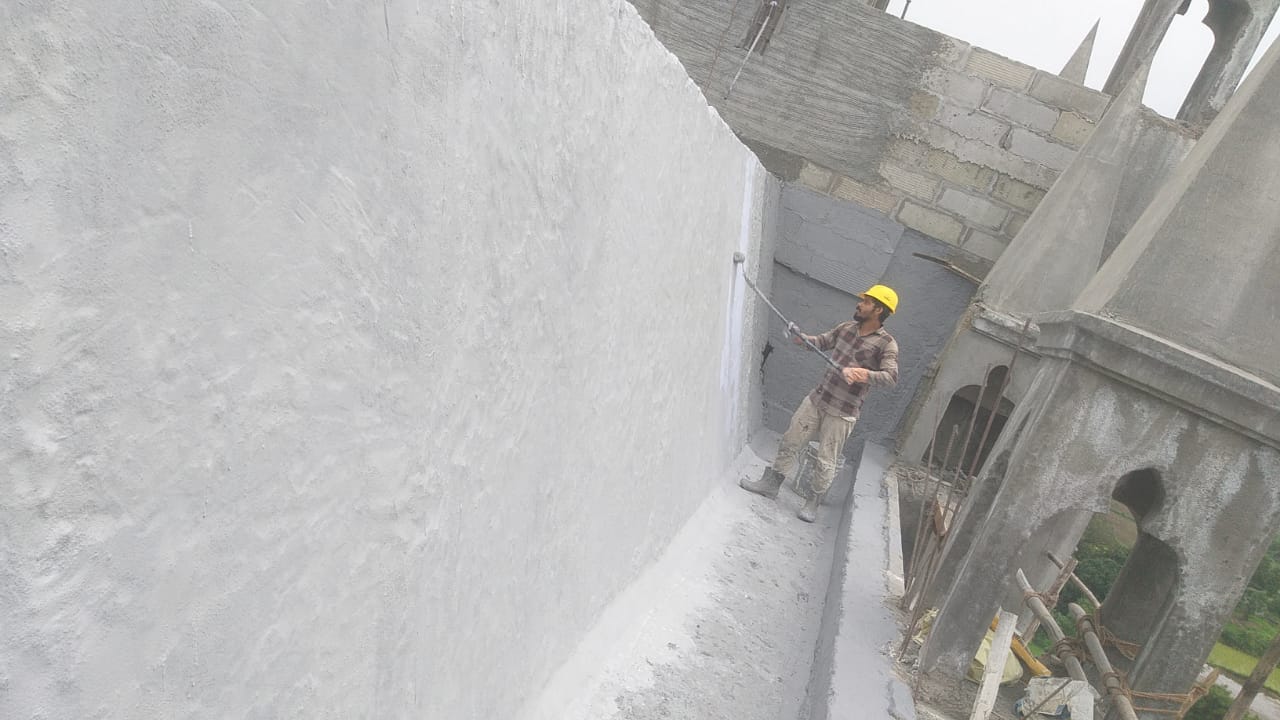

Terrace Waterproofing 1

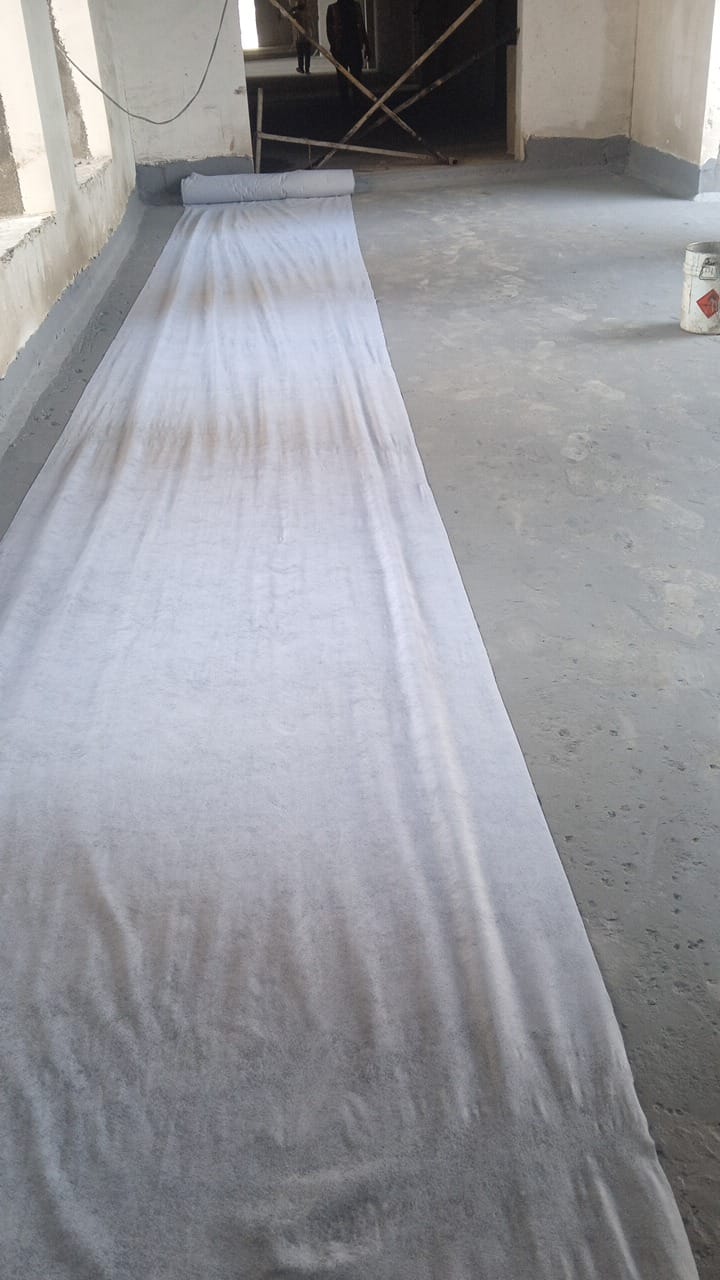

Terrace Waterproofing 2
Terrace Waterproofing 3

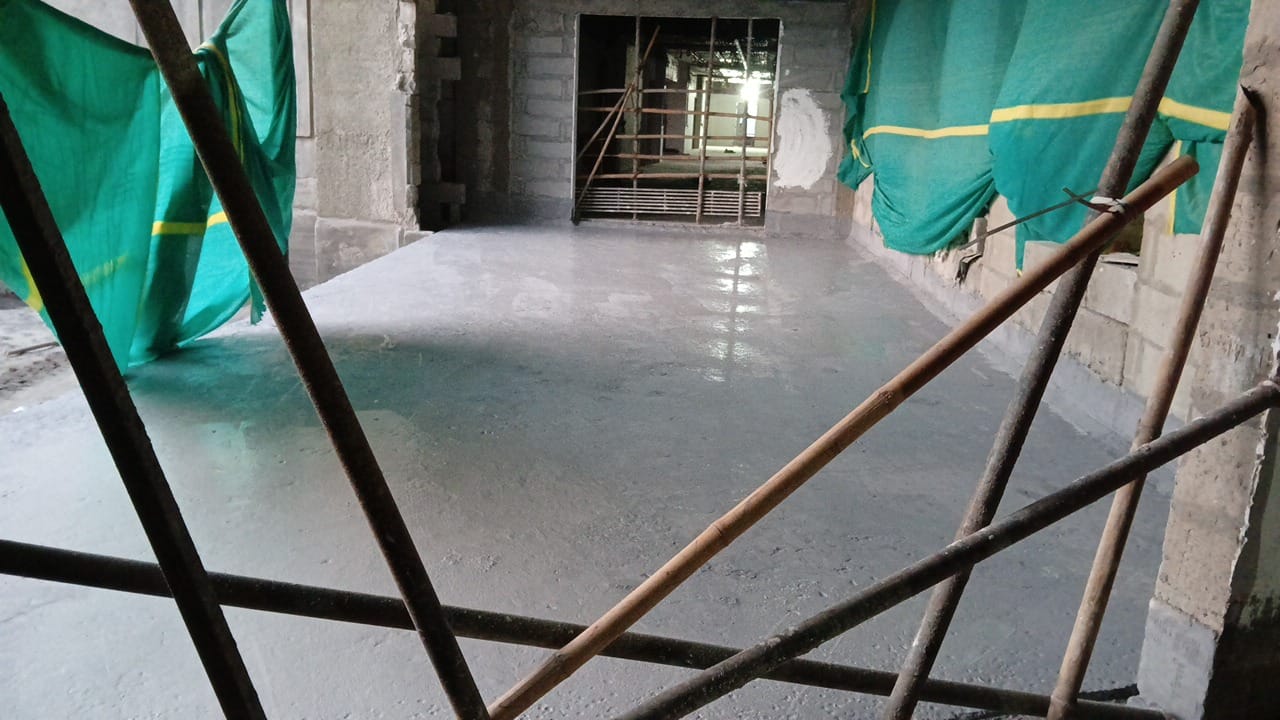

Terrace Waterproofing 4
Terrace Waterproofing 5

Terrace Waterproofing 6

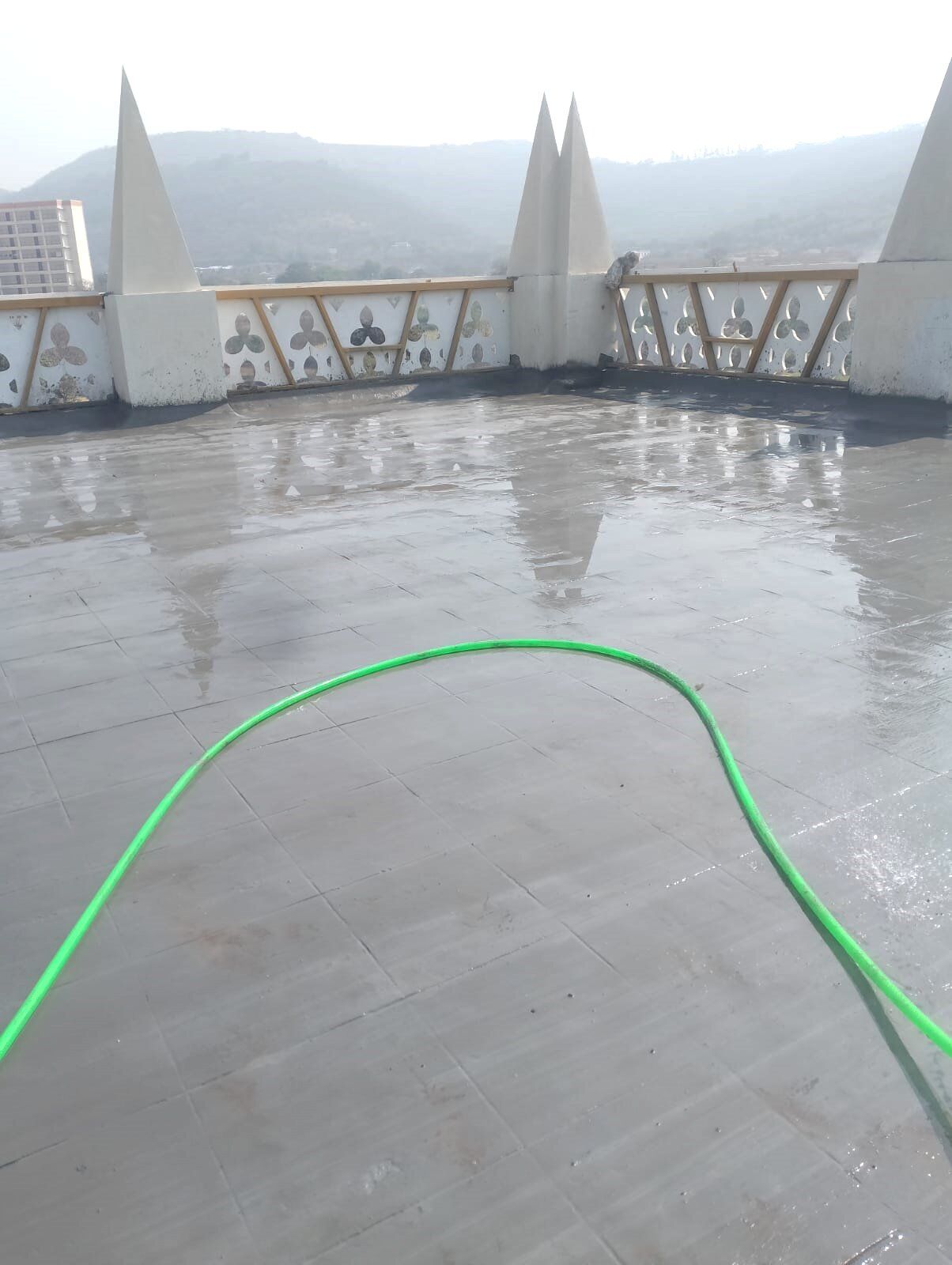

Terrace Waterproofing 7

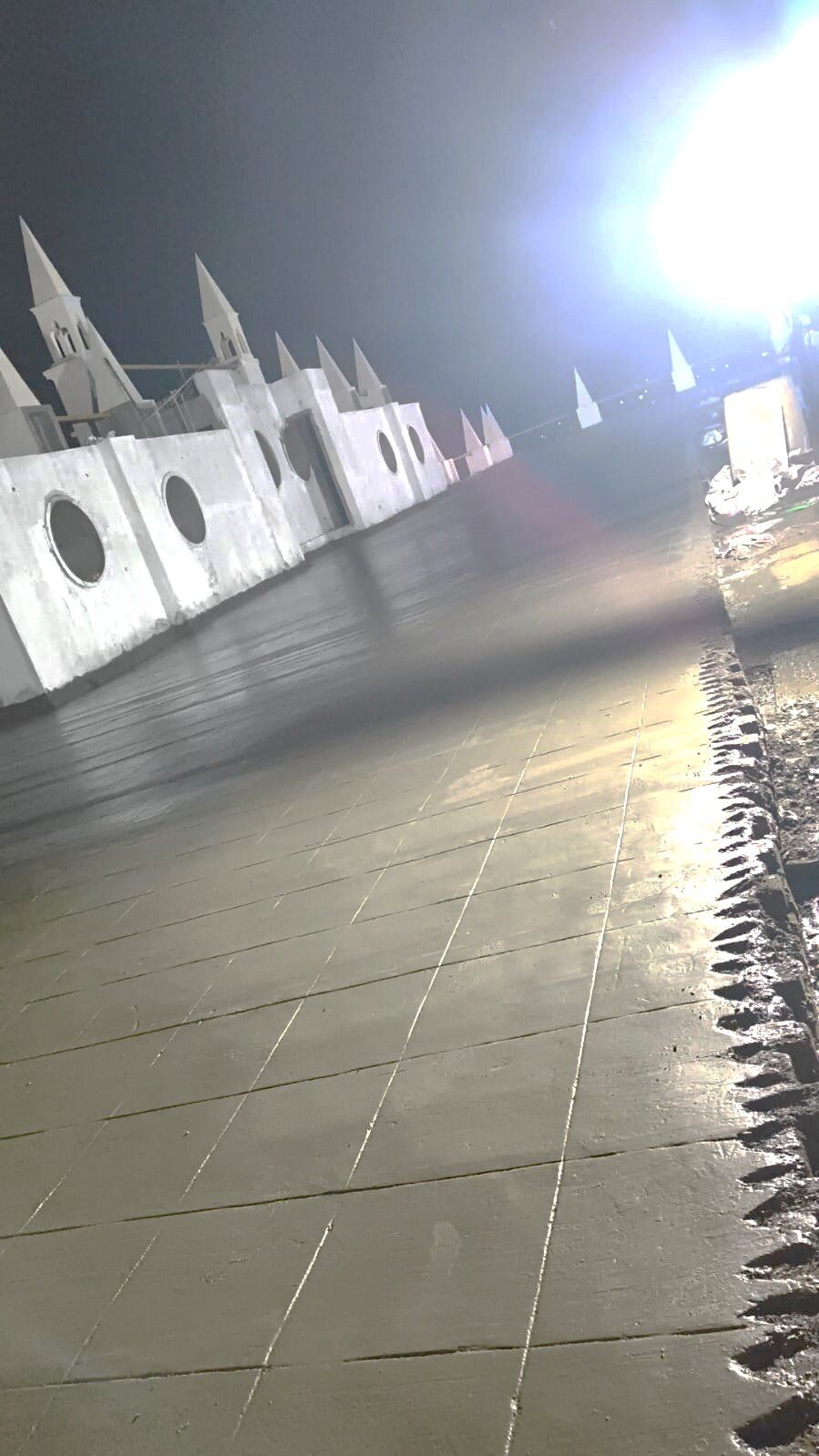

Terrace Waterproofing 8

Podium Waterproofing

Podium Waterproofing Works

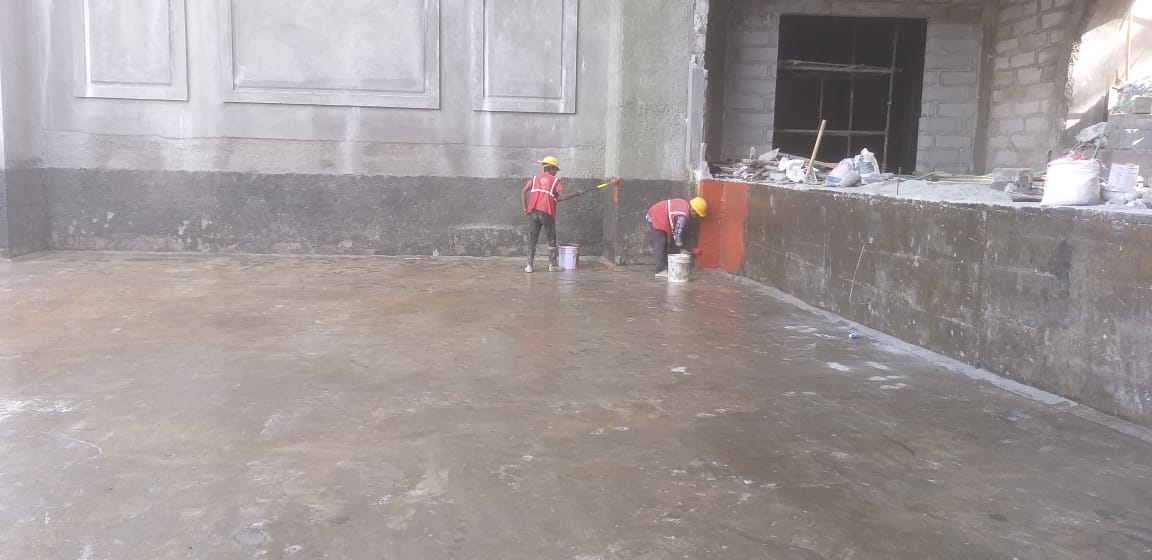

Podium Waterproofing 1

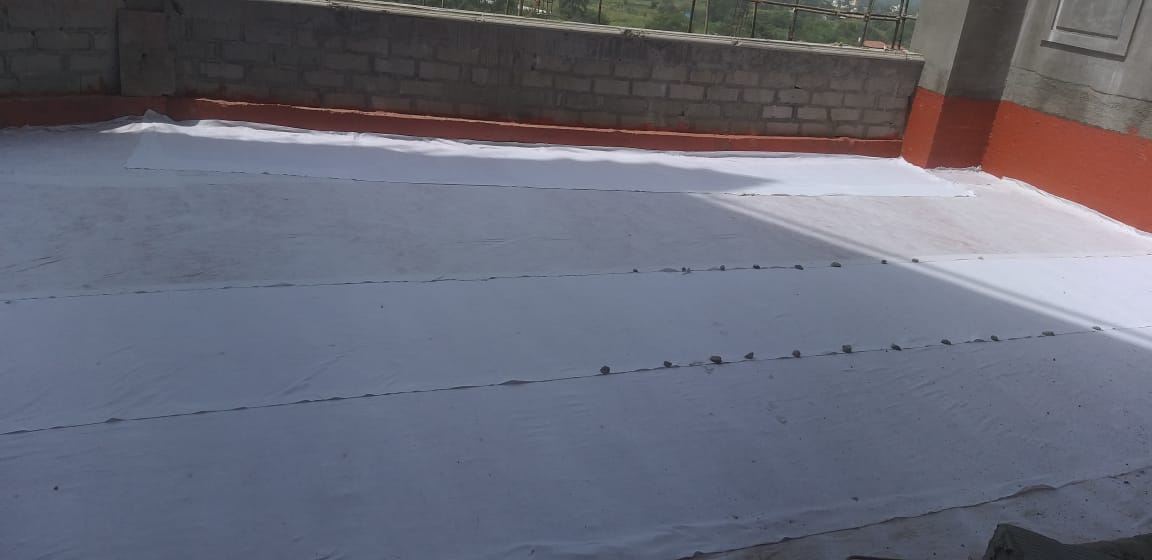

Podium Waterproofing 2

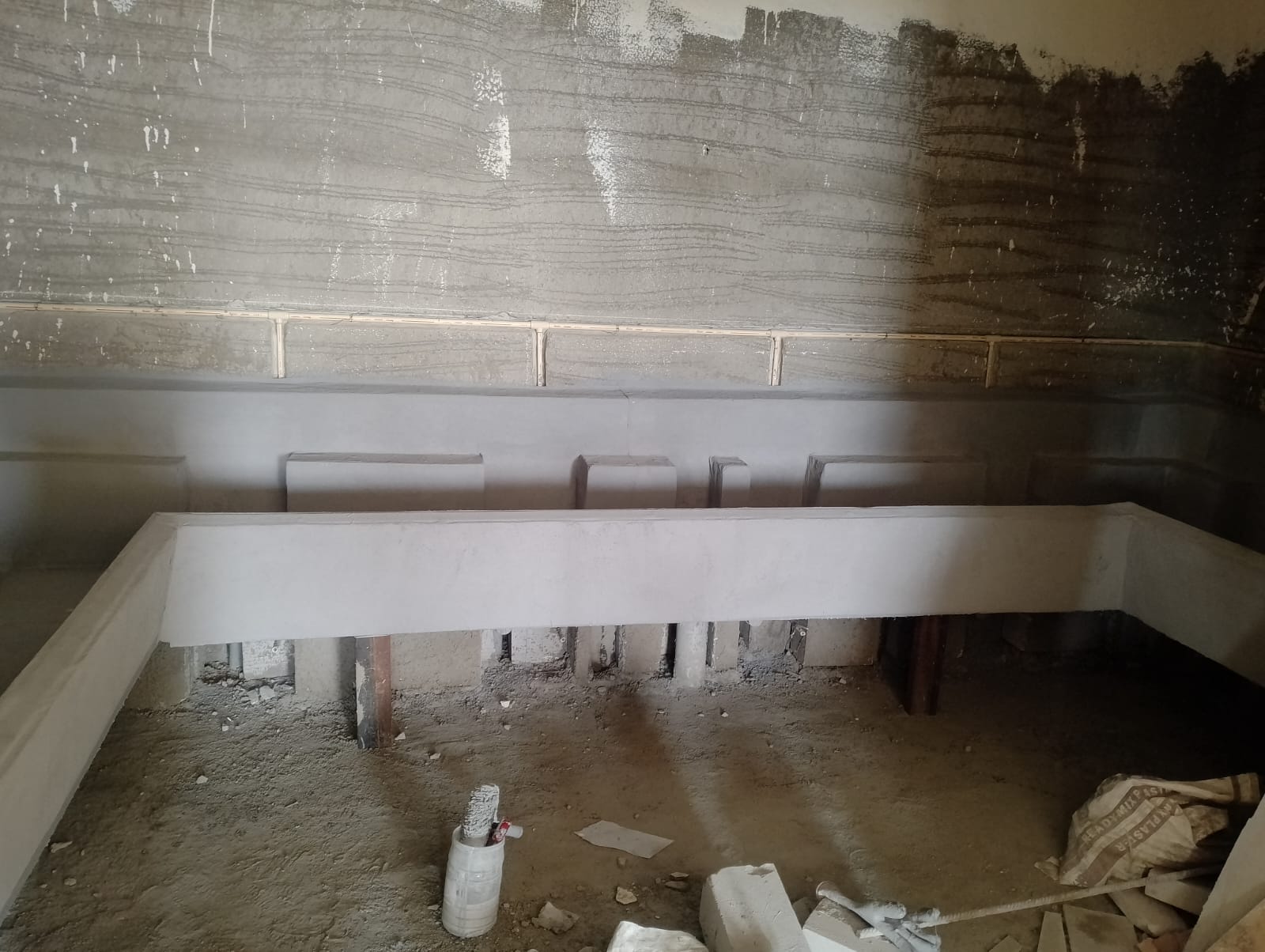

Podium Waterproofing 3

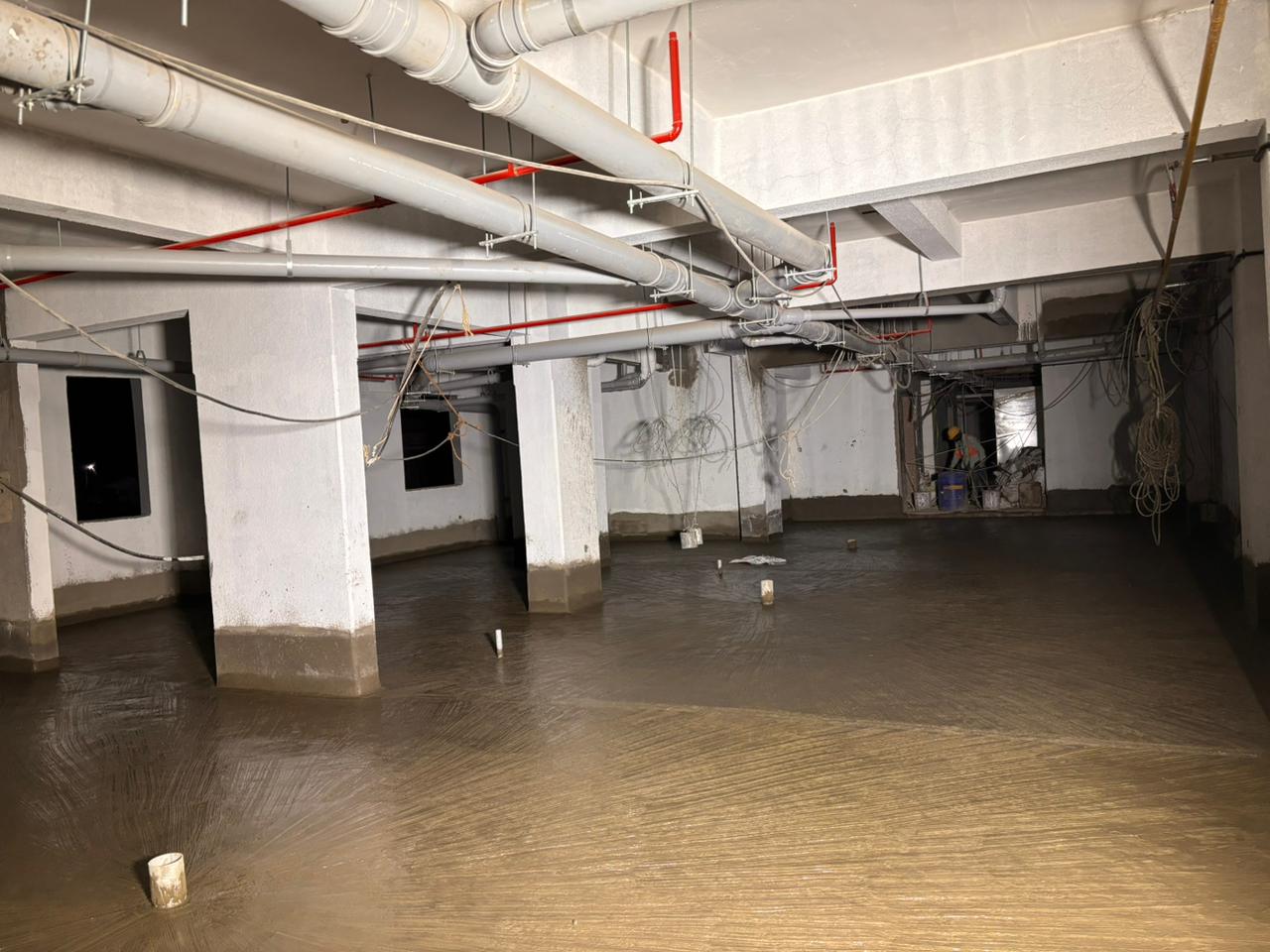

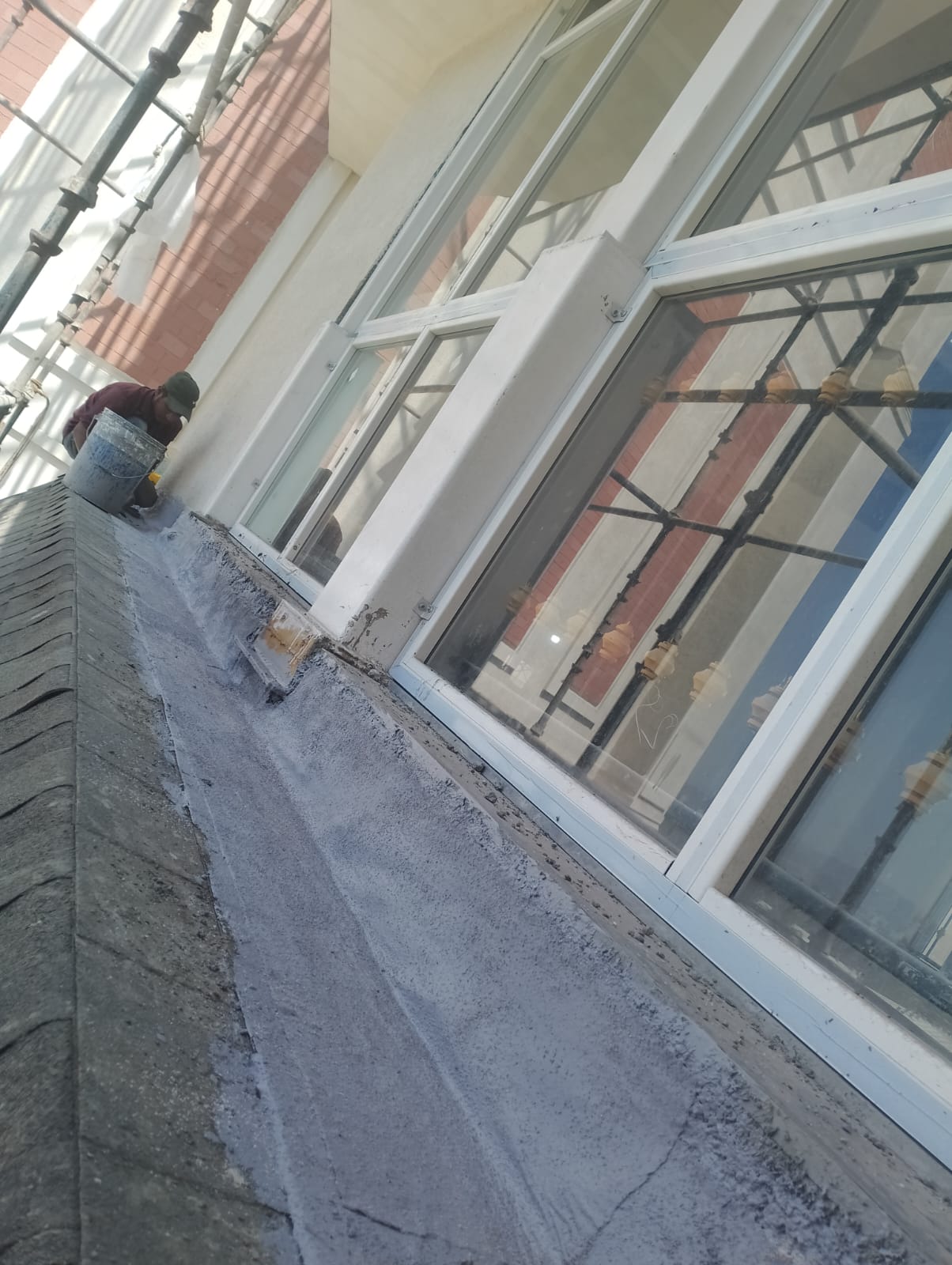

Podium Waterproofing 4

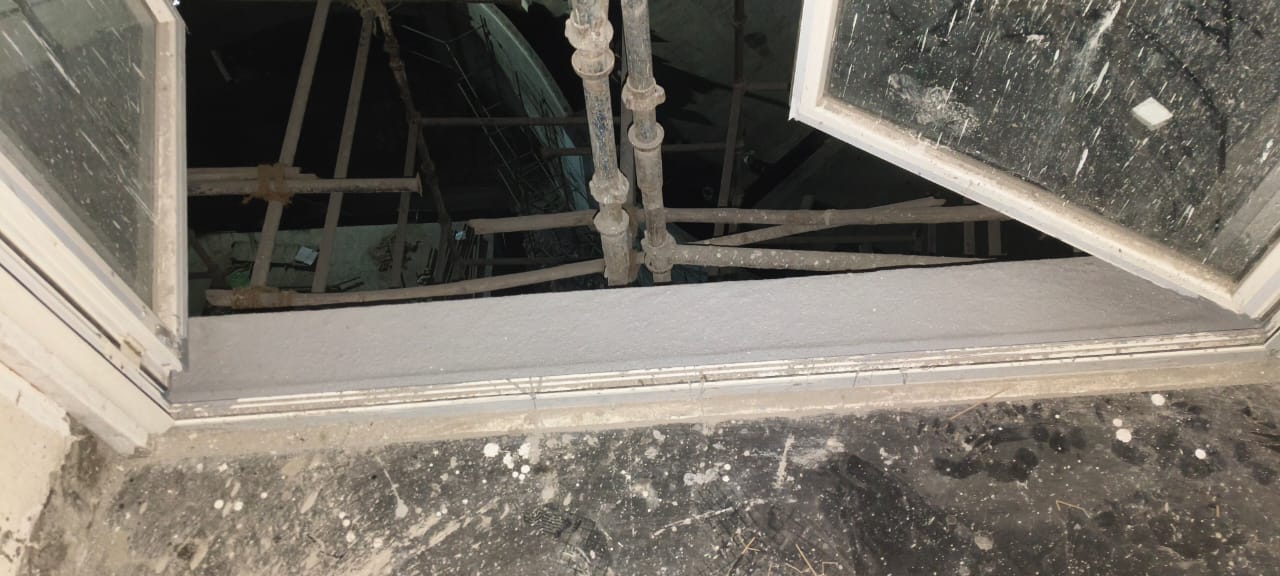

Podium Waterproofing 5
Podium Waterproofing 6
Podium Waterproofing 7

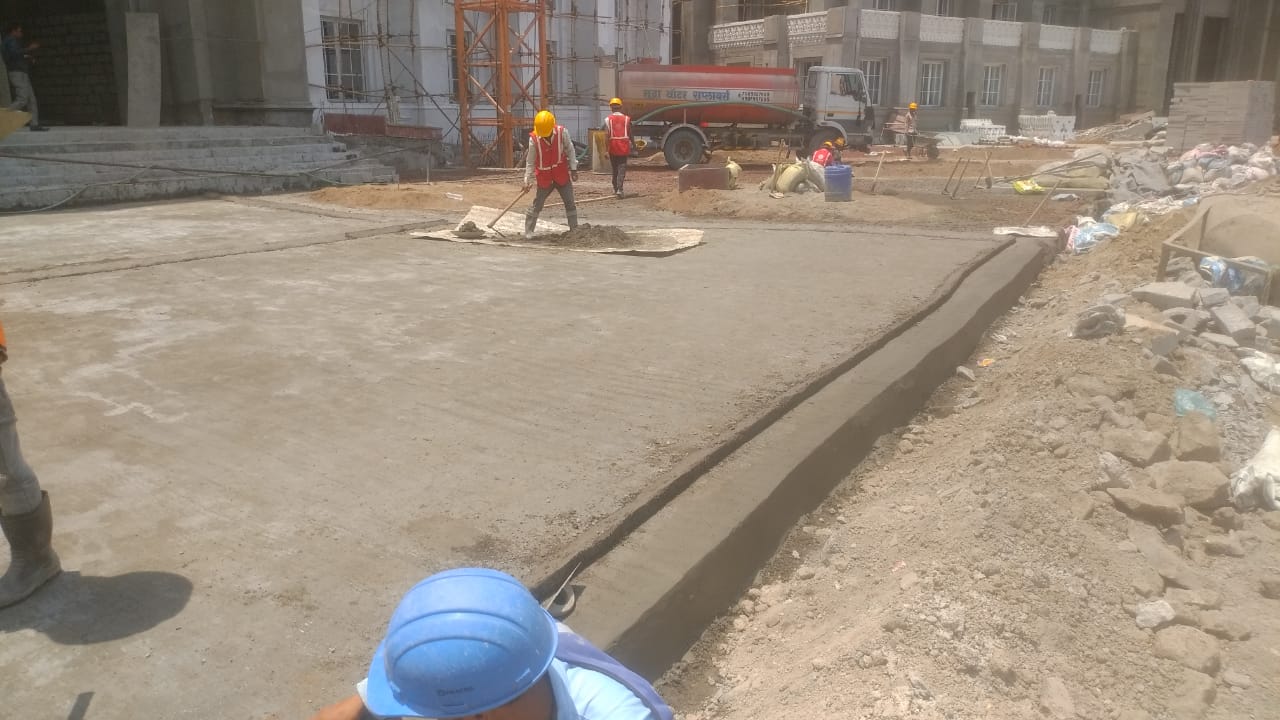

Podium Waterproofing 8

Ramp Waterproofing

Step 1: Surface Preparation

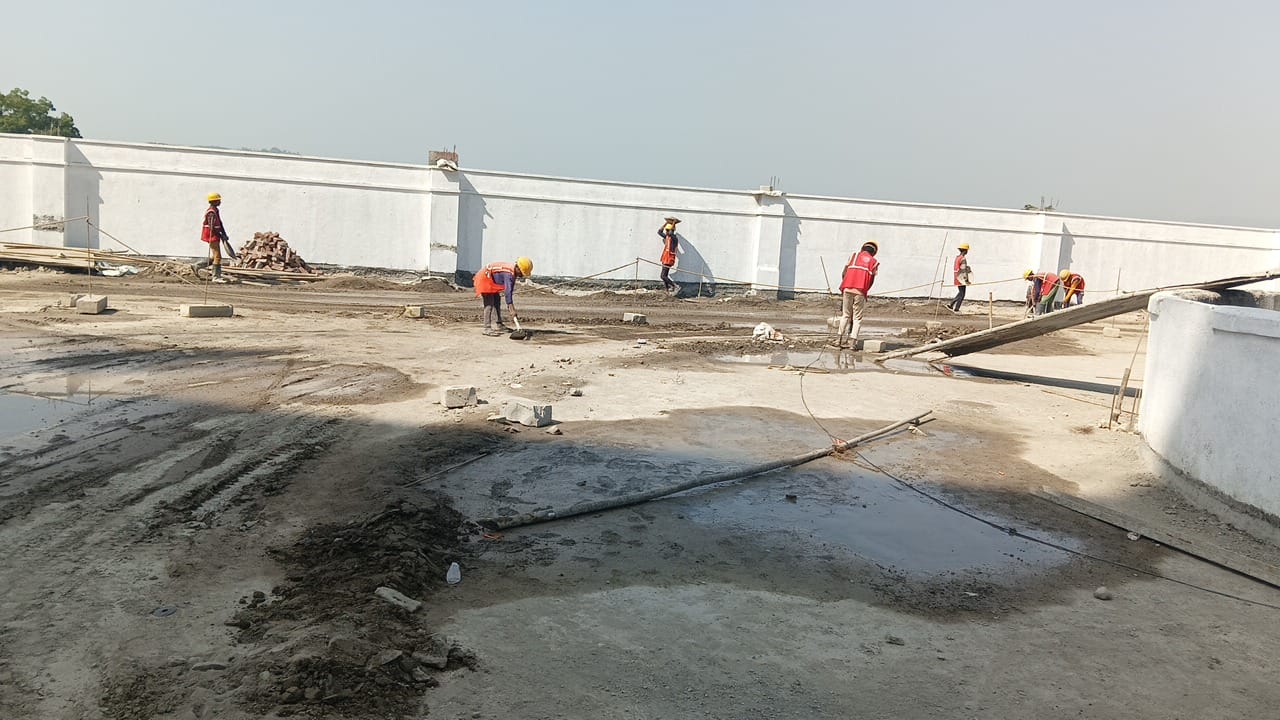

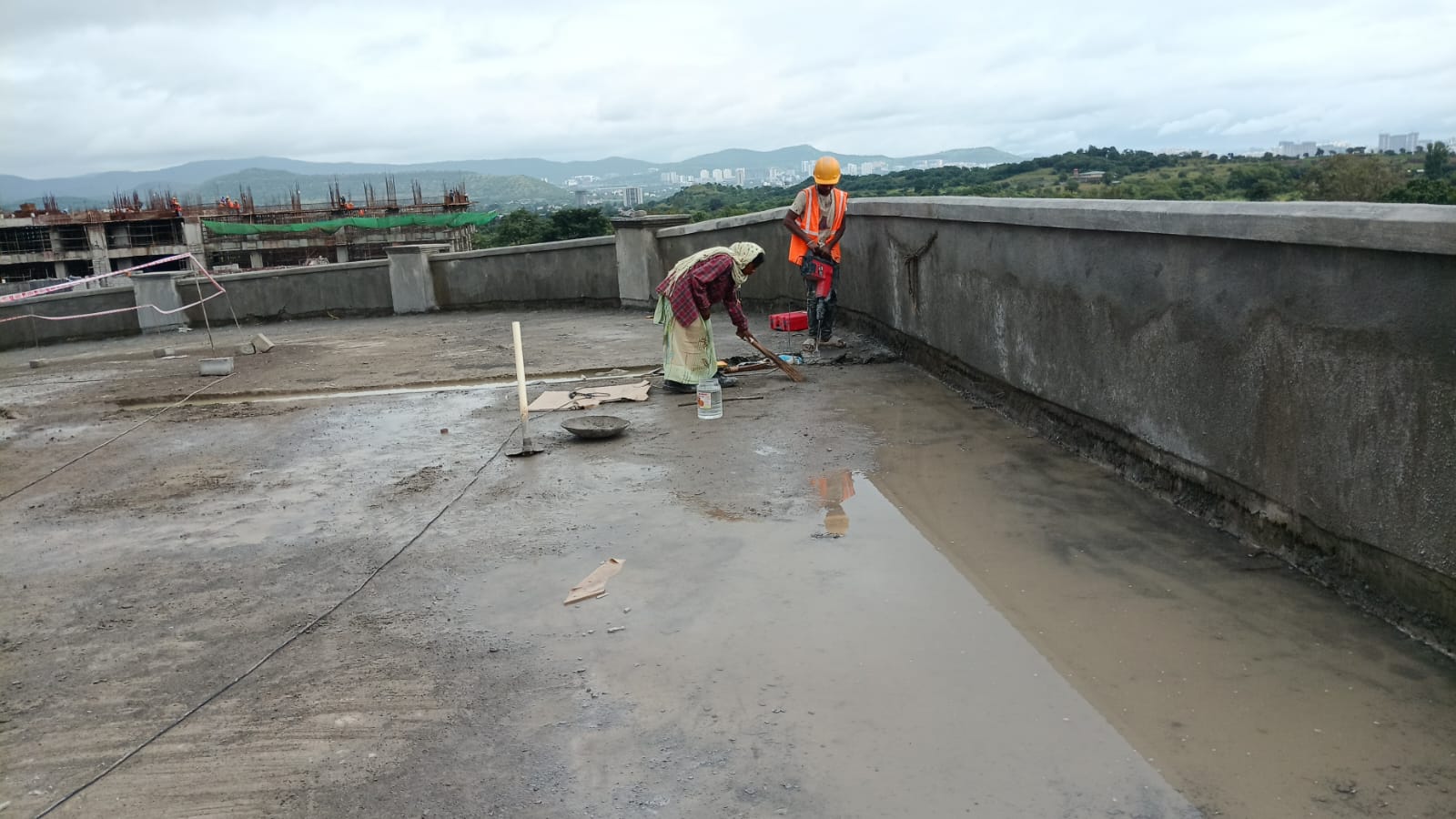

Ramp Surface Preparation 1
Ramp Surface Preparation 2

Step 2: Primer Application

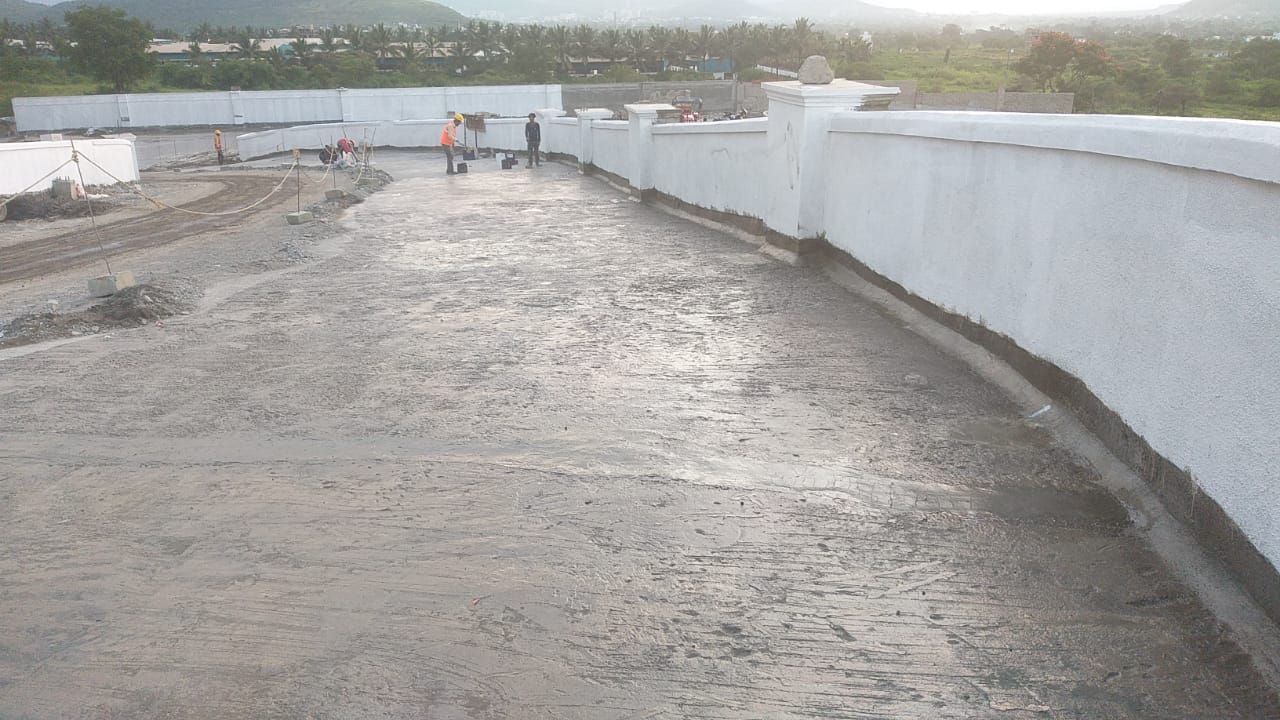

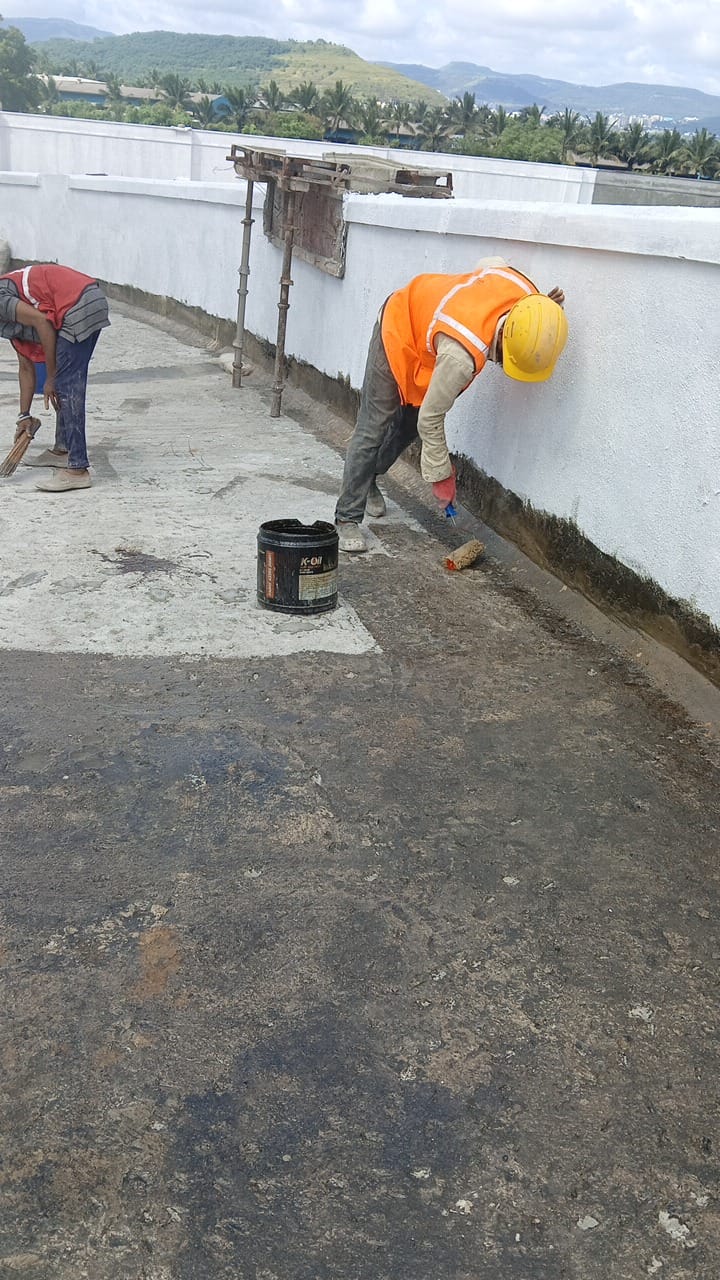

Ramp Primer Application 1
Ramp Primer Application 2

Step 3: Chemical Coat

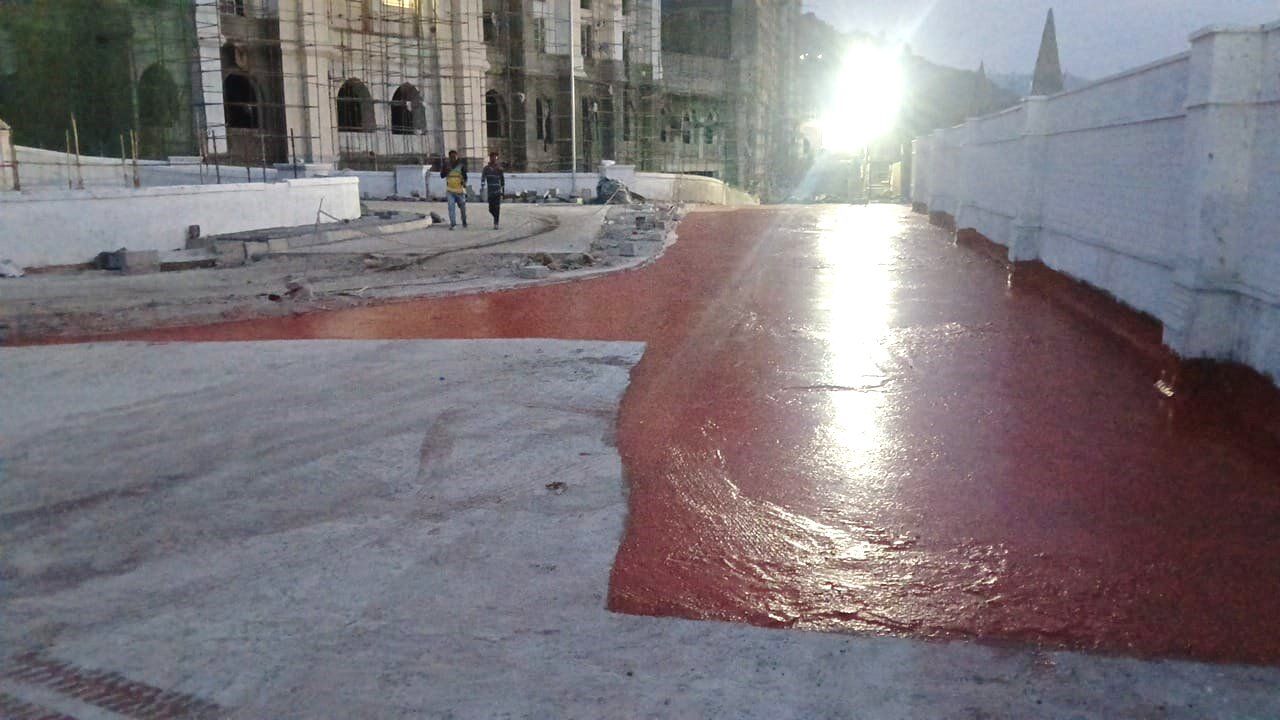

Ramp Chemical Coat 1

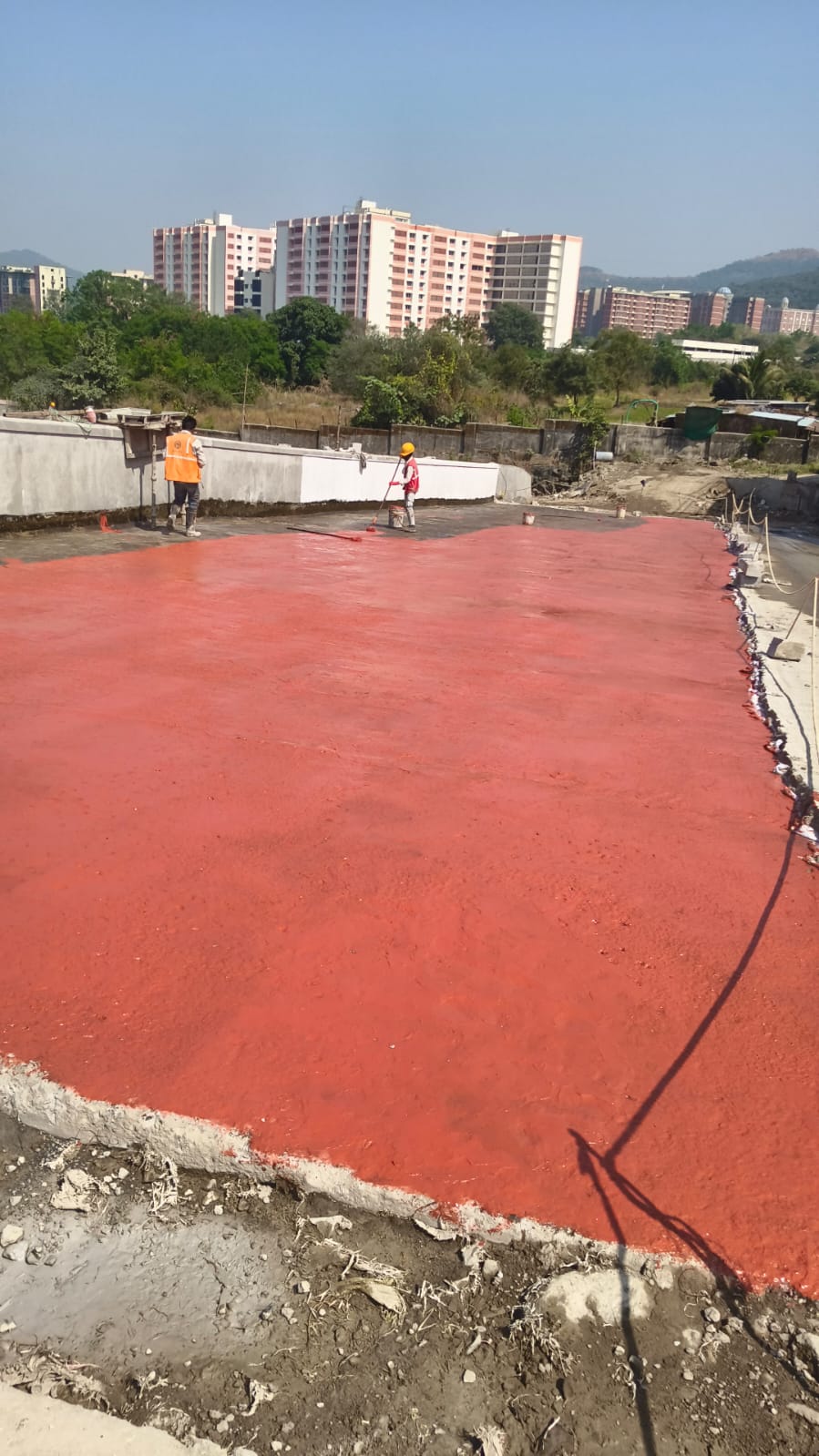

Ramp Chemical Coat 2

Step 4: Geotextile Laying

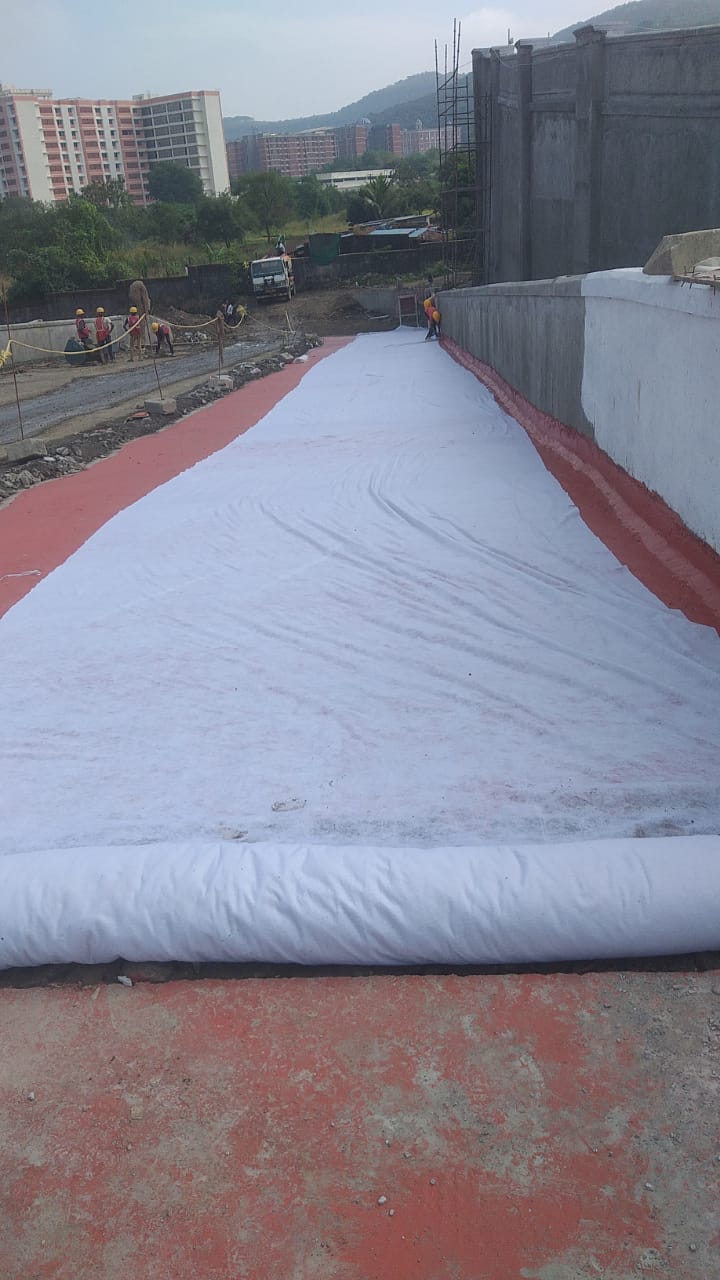

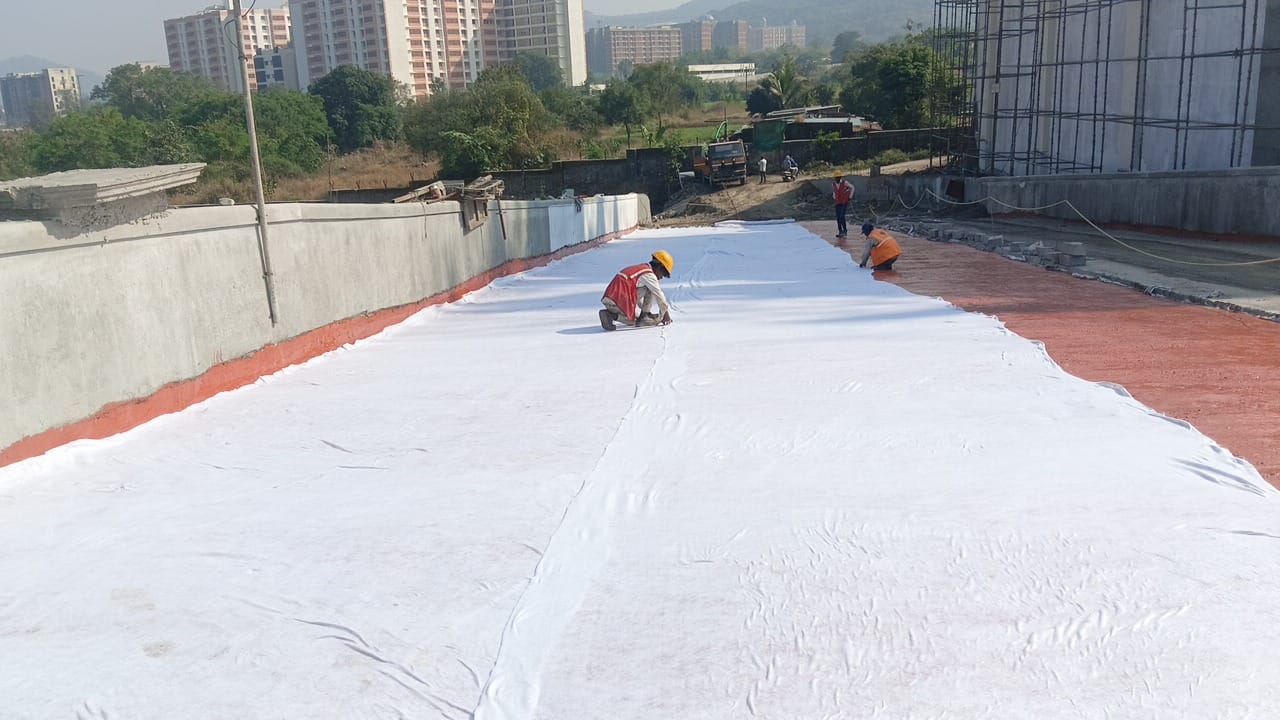

Ramp Geotextile Laying 1
Ramp Geotextile Laying 2

Step 5: Final Screed

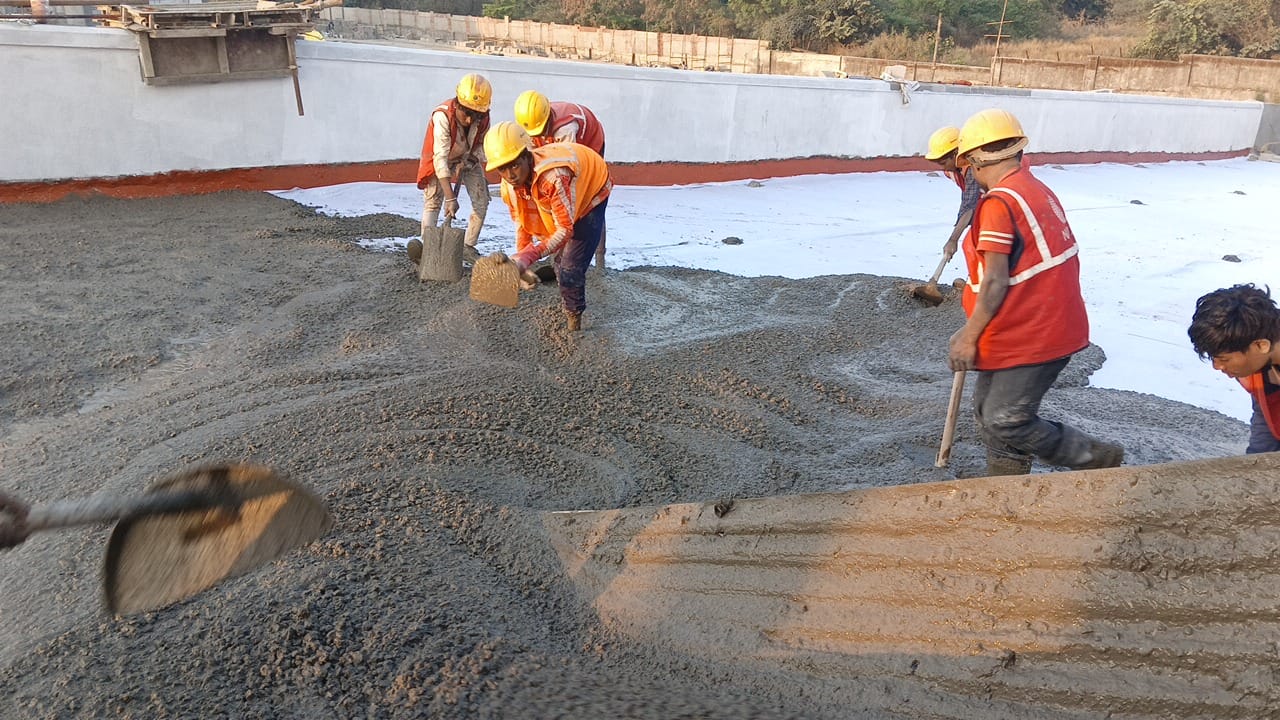

Ramp Final Screed 1

Dome Waterproofing

Step 1: Chemical Coat

Dome Chemical Coat 1
Dome Chemical Coat 2

Step 2: Brick Bat

Dome Brick Bat 1

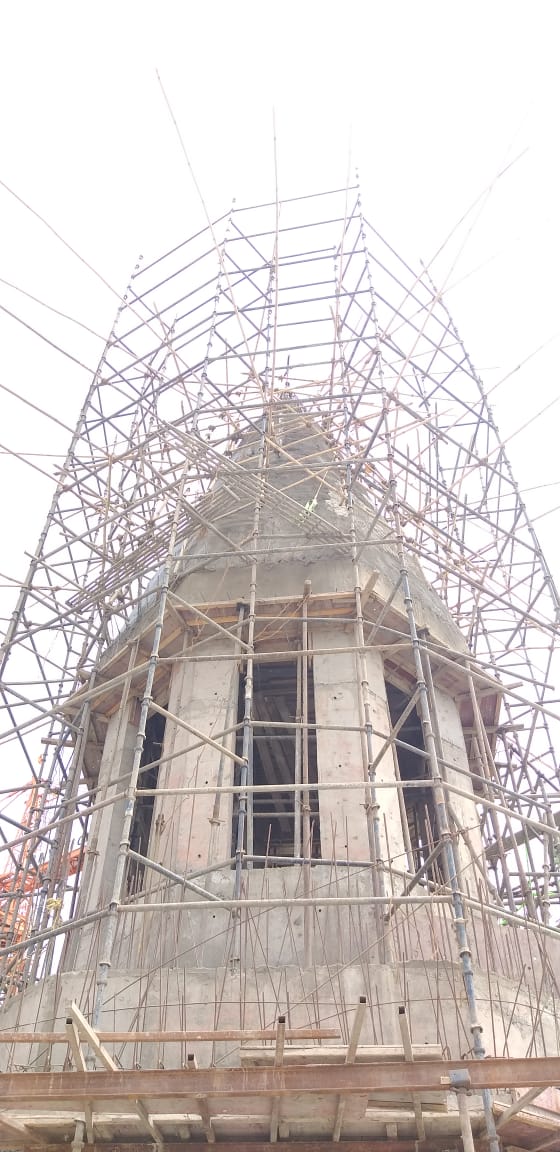

Dome Brick Bat 2

Step 3: Final Finishing

Dome Final Finishing 1
Dome Final Finishing 2

Expansion Joint Waterproofing

Expansion Joint Treatment Work

Expansion Joint Treatment 1

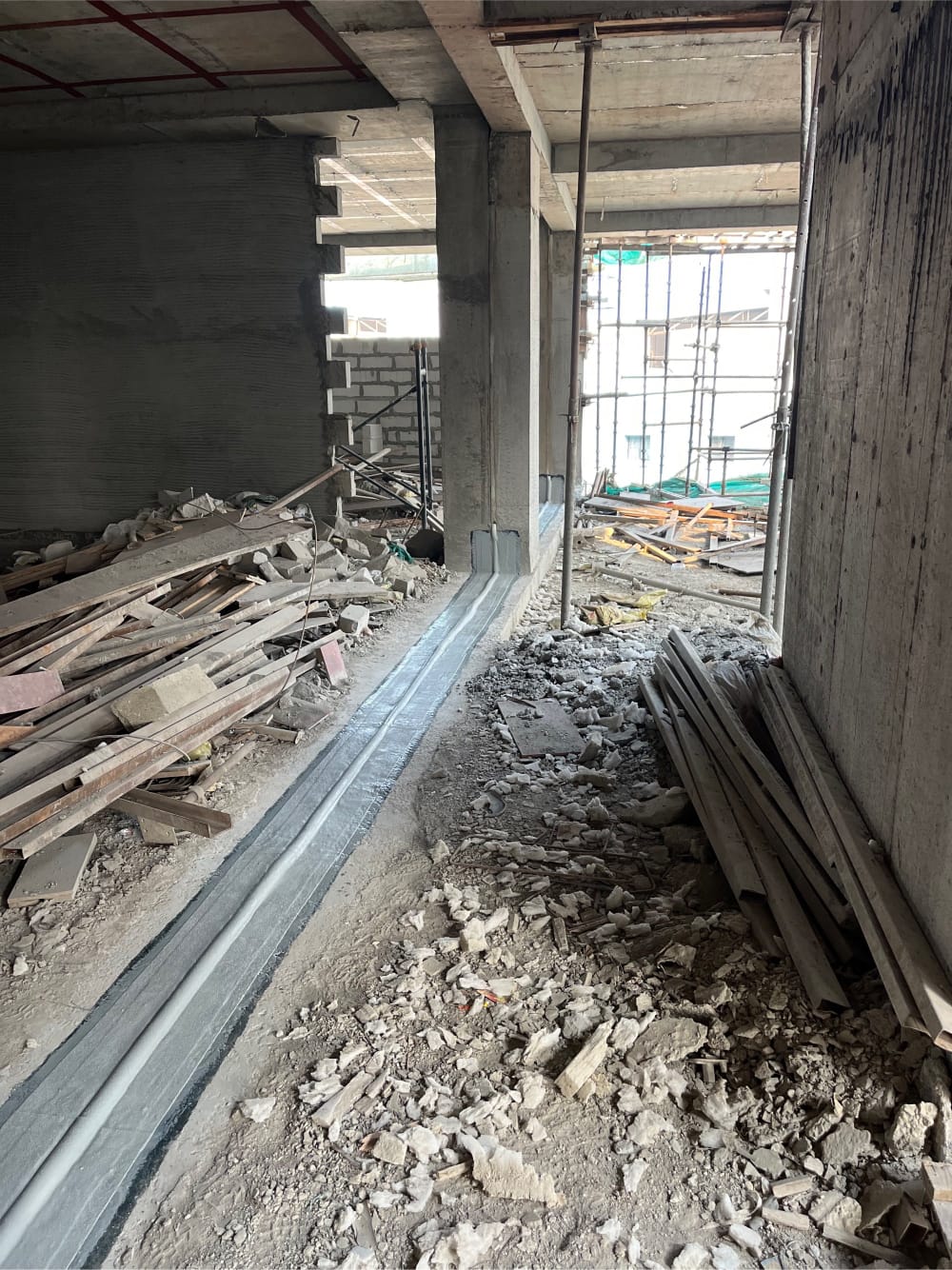

Expansion Joint Treatment 2
Expansion Joint Treatment 3
